Question

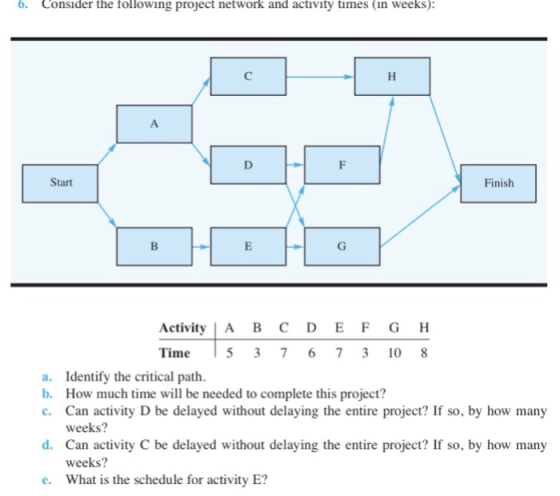

6. Consider the following project network and activity times (in weeks): Start Finish Activity | A BC DEFG H Time 15 376 73 1

These can be computed exactly using the normal distribution.
Please show all working
0 0
Add a comment Improve this question Transcribed image text
Answer #1

oret Patu Time 5+1+8 A CH 20 = B E G A D G BEFH fath ADFH bath. So it Cau wtthout dalayivg fhe entire se dalated winnaut d A(b) Time needed to complete a project is the time of Critical Path = 22

Add a comment
