Question

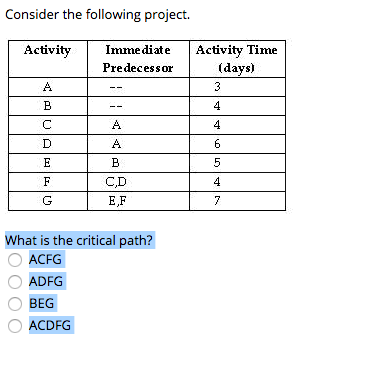

Consider the following project. Activity ImmediateActivity Time (days) Predecessor CD E,F What is the critical path? O ACFG O

What is the latest finish time for activity F? 0 9 O 13 O 16

What is the latest possible time that Activity E can be started without delaying the completion of the project?

What is the latest time that activity B can finish without delaying any other activities? 4

What is the latest time that activity B can start without delaying the project? 4

What is the minimum possible time for completing this project? O15 days 16 days O 18 days 20 days

Consider the following project. Activity ImmediateActivity Time (days) Predecessor CD E,F What is the critical path? O ACFG O ADFG OBEG ACDFG
What is the latest finish time for activity F? 0 9 O 13 O 16
What is the latest possible time that Activity E can be started without delaying the completion of the project?
What is the latest time that activity B can finish without delaying any other activities? 4
What is the latest time that activity B can start without delaying the project? 4
What is the minimum possible time for completing this project? O15 days 16 days O 18 days 20 days
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Page L Date LSİLE C. 0 6 3 3 20 13/20 8 13 tvite St ft 3-3-0 2 eto me leYPage L Date LSİLE C. 0 6 3 3 20 13/20 8 13 tvite St ft 3-3-0 2 eto me leY
