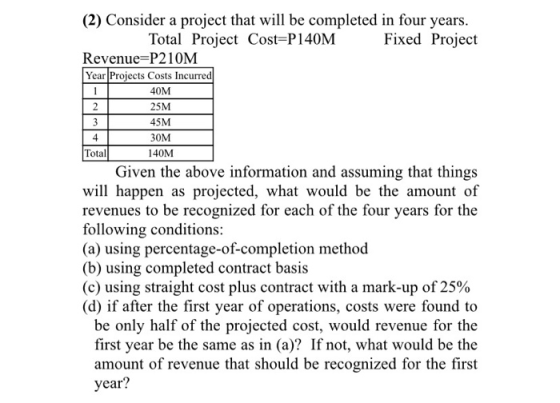

(2) Consider a project that will be completed in four years. Total Project Cost=P140M Fixed Project...
In 2015 The Big Boss Construction Company, started a 3 year project at a fixed contract price of $22,000,000. The estimated construction costs were $15,500,000. The project was completed on time during the 2917 year. The following information is available for the three year period of the construction project. 2015 2016 2017 Costs Incurred to Date $6,188,000 $12,360,000 $15,875,000 Estimated Costs to Complete 9,282,000 3,090,000 -- Billings to Date 6,400,000 18,890,000 22,000,000 Collections to Date 5,100,000 17,110,000 21,630,000 Required 1....
Curtiss Construction Company, Inc., entered into a fixed price contract with Axelrod Associates on July 1, 2021, to construct a four-stor office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,240,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Axelrod under...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,600,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Axelrod under the...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,420,000. Curtiss concludes that the contract does not qualify for revenue recognition over time. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred,...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2018, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,540,000. Curtiss concludes that the contract does not qualify for revenue recognition over time. The building was completed on December 31, 2020. Estimated percentage of completion, accumulated contract costs incurred,...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,960,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Axelrod under the...
Assume Nortel Networks contracted to provide a customer with Internet infrastructure for $2,500,000. The project began in 2018 and was completed in 2019. Data relating to the contract are summarized below: 2018 2019 Costs incurred during the year $ 340,000 $ 1,940,000 Estimated costs to complete as of 12/31 1,360,000 0 Billings during the year 451,000 1,720,000 Cash collections during the year 270,000 1,800,000 Required: 1. Compute the amount of revenue and gross profit or loss to be recognized in...
Assume Nortel Networks contracted to provide a customer with
Internet infrastructure for $2,600,000. The project began in 2021
and was completed in 2022. Data relating to the contract are
summarized below:
2021
2022
Costs incurred during the year
$
348,000
$
1,995,000
Estimated costs to complete as of 12/31
1,392,000
0
Billings during the year
465,000
1,740,000
Cash collections during the year
395,000
1,810,000
Required:
1. Compute the amount of revenue and gross profit or loss to be
recognized in...
Check my work 10 Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,000,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings...
Beavis Construction Company was the low bidder on a construction project to build an earthen dam for $1,890,000. The project was begun in 2017 and completed in 2018. Cost and other data are presented below: 2017 2018 Costs incurred during the year $ 423,000 $ 1,190,000 Estimated costs to complete 987,000 0 Billings during the year 445,000 1,445,000 Cash collections during the year 345,000 1,545,000 Assume that Beavis recognizes revenue on this contract over time according to percentage of completion....
