Answer:

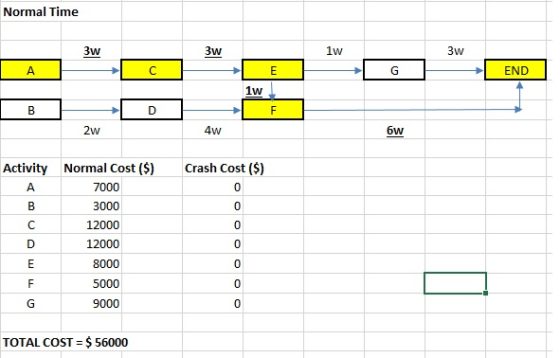

a. The shortest time duration for this project regardless of cost is 5 weeks.

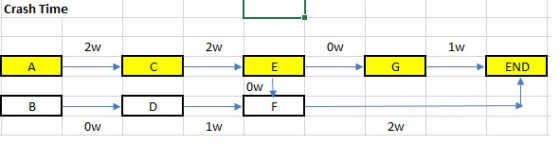

The Network diagram of the same is as below,

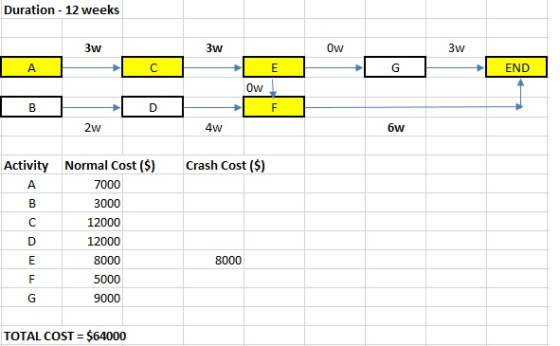

b. The minimum total cost estimate of this project to complete in 12 weeks duration is $64000/-

C. Total Time to minimum cost schedule is 13 weeks.

The table below contains data for the installation of new equipment in a manufacturing process at...
Software Installation: You are the project manager of the software installation project (see figure & table) below. You would like to find the minimum-cost schedule for your project. There is a $1,000-per-week penalty for each week the project is delayed beyond week 25. In addition, your project team determined that indirect project costs are $2,500 per week. Oo un D FINISH START START I Normal Normal Crash Crash Max reduction $ per Week Activity Time Cost Time Cost AI 5...
Also solve for the minimum total cost
associated with finishing the project in 13 weeks and the total
project's duration (and of each activity according to the minimum
cost schedule)

The table below contains data for the installation of new equipment in a manufacturing process at Excello Corporation. Your company is responsible for the installation project. Indirect costs are $10,000 per week, and a penalty cost of $8,000 per week will be incurred by your company for every week the...
You are the manager of a project to improve a billing process at your firm. The table below contains the data you will need to conduct a cost analysis of the project Indirect costs are $1,600 per week, and penalty costs are $600 per week after week 12 Immediate Normal Cost Crash Cost Predecessor(s) Normal Time (weeks) Crash Time (weeks) ($) ($) Activity A 4 5,500 7,500 В 5 3 8,000 9,500 A 1 1 3,500 3,500 В 6 3...
The Advanced Tech Company has a project to design an integrated information data base for a major bank. Data for the project are given in the following table. Indirect project costs amount to S150 per day. The company will incur a $100 per day penalty for each day the project lasts beyond day 15. Normal Time Crash Time Crash Cost Immediate Normal Cost ($) Activity (S) (days) (days) Predecessor(s) 6 800 1,200 A 4 6 1,000 2,200 C 600 1...
The Advanced Tech Company has a project to design an integrated information data base for a major bank. Data for the project are given $150 per day. The company will incur a $100 per day penalty for each day the project lasts beyond day 15. the following table. Indirect project costs amount to Normal Time Crash Time Crash Cost Immediate Normal Cost (S) Activity Predecessor(s) (S) (days) (days) 1.200 A 6 800 4 6 1,000 2 2,200 600 900 C...
Consider the project network information in Table 1 of Case Study A on Page 3 below. Assuming the project starts at time zero and all activity connections are finish-to-start, draw an Activity on the Node (AON) network diagram of the project, determine the expected project completion time, state the critical activities and critical path(s). Crash the project by 1 week and state the total crash cost. (b) (18 narl Case Study A Table 1 below contains activities associated with a...
Consider the project network information in Table 1 of Case Study A on Page 3 below. Assuming the project starts at time zero and all activity connections are finish-to-start, draw an Activity on the Node (AON) network diagram of the project, determine the expected project completion time, state the critical activities and critical path(s). Crash the project by 1 week and state the total crash cost. (b) (18 nar Case Study A Table 1 below contains activities associated with a...
Development of Version 2.0 of a particular accounting software product is being considered by Jose Noguera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: Activity Normal Time(weeks) Crash Time(weeks) Normal Cost Total Cost with Crashing Immediate Predecessor(s) A 44 33 $ 2 comma 000$2,000 $ 2 comma 650$2,650 long dash— B 22 11 $ 2 comma 200$2,200 $ 3 comma 000$3,000 long dash— C 33 33 $...
Table 2 contains information about an environmental cleanup project in the township of Hiles. Shorten the project 3 weeks by finding the minimum-cost schedule. Assume that project indirect costs and penalty costs are negligible. Identify activities to crash while minimizing the additional crash costs. What is the project’s duration if only normal times are used? What is the minimum-cost schedule? What is the critical path for the minimum-cost schedule? TABLE 2 Activity Normal Time (wks) Crash Time (wks) Cost to...
Question 2. (30%) The following table provides the information necessary to construct project network and calculate a total project cost. In case of activity crash, the information includes crash cost for each activity. Activity Immediate predecessor(s) Activity time (weeks) Normal cost (x1000$) Additional cost for crashing one week (x1000$) Normal After maximum crash A - 16 12 2,000 300 B - 14 9 1,000 160 C A 8 6 500 100 D A 5 4 600 700 E B 4...
