(b)
The critical path of a project is composed off activities with zero total slack. The critical path(s) is/ are the longest path(s) in a project network. The slacks for each activity can be computed by carrying out forward pass and backward pass in the project network.
Forward Pass:
ES of the starting activities = 0
ES of all other activities = Max. (EF of their immediate predecessors)
EF of an activity = Its ES + Its duration
Backward Pass:
LF of ending activities = Max. (All the EFs)
LF of all other activities = Min. (LS of their immediate successors)
LS of an activity = Its LF - Its duration
Total slack (or, float) = LF - EF for each activity.
| Activity | Duration | ES | EF | LS | LF | Slack |
| A | 90 | 0 | 90 | 0 | 90 | 0 |
| B | 15 | 90 | 105 | 95 | 110 | 5 |
| C | 5 | 105 | 110 | 110 | 115 | 5 |
| D | 20 | 129 | 149 | 129 | 149 | 0 |
| E | 21 | 149 | 170 | 173 | 194 | 24 |
| F | 25 | 90 | 115 | 90 | 115 | 0 |
| G | 14 | 115 | 129 | 115 | 129 | 0 |
| H | 28 | 149 | 177 | 166 | 194 | 17 |
| I | 30 | 90 | 120 | 119 | 149 | 29 |
| J | 45 | 149 | 194 | 149 | 194 | 0 |

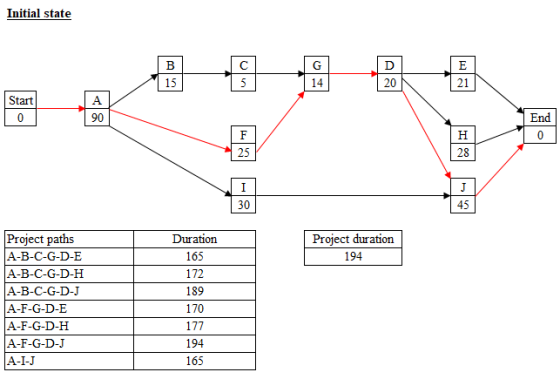

The critical path is constituted by activities with slack=0. So, the critical path is A-F-G-D-J with project completion time=194 days.
(c)
First, compute the cost slope using the following formula:
Slope = (Crash cost - Normal cost) / (Normal time - Crash time)
| Activity | Normal time | Normal cost | Crash time | Crash cost | Slope | Max crash limits |
| A | 90 | 2250 | 85 | 2520 | 54.00 | 5 |
| B | 15 | 180 | 13 | 210 | 15.00 | 2 |
| C | 5 | 90 | 4 | 120 | 30.00 | 1 |
| D | 20 | 300 | 16 | 340 | 10.00 | 4 |
| E | 21 | 231 | 17 | 315 | 21.00 | 4 |
| F | 25 | 250 | 22 | 375 | 41.67 | 3 |
| G | 14 | 70 | 12 | 112 | 21.00 | 2 |
| H | 28 | 392 | 25 | 448 | 18.67 | 3 |
| I | 30 | 510 | 28 | 570 | 30.00 | 2 |
| J | 45 | 1350 | 41 | 1530 | 45.00 | 4 |
Always select activities on the critical paths for crashing which has the minimum slope.

The step-3 is the last step because the project duration has been reduced to 186 days. The activities crashed were D (4 days), G (2 days), and F (2 days). The total minimum cost is 5,788.33 ($,000).
