Question

at PBI airport. The table aso provides the immedate predecessor event for each activity and the optimistic [ol, most lkely Im
0 0
Add a comment Improve this question Transcribed image text
Answer #1
Time(days)
activity predecessor a m b Ex Time = a+b+4m / 6 Std Dev =b-a / 6 Variance =Std Dev ^2 ES EF Critical LS LF Slack
A - 2 4 6 4.00 0.67 0.44 0.00 4.00 4.50 8.50 4.50
B - 2 2 3 2.17 0.17 0.03 0.00 2.17 3.67 5.83 3.67
C - 5 8 12 8.17 1.17 1.36 0.00 8.17 Yes 0.00 8.17 0.00
D A 4 6 10 6.33 1.00 1.00 4.00 10.33 8.50 14.83 4.50
E D 7 9 12 9.17 0.83 0.69 10.33 19.50 14.83 24.00 4.50
F A 3 4 8 4.50 0.83 0.69 4.00 8.50 14.67 19.17 10.67
G F 5 7 9 7.00 0.67 0.44 8.50 15.50 19.17 26.17 10.67
H E 1 2 4 2.17 0.50 0.25 19.50 21.67 24.00 26.17 4.50
I B 2 3 6 3.33 0.67 0.44 2.17 5.50 5.83 9.17 3.67
J I 1 2 4 2.17 0.50 0.25 5.50 7.67 9.17 11.33 3.67
K J 4 5 8 5.33 0.67 0.44 7.67 13.00 11.33 16.67 3.67
L C 1 1 1 1.00 0.00 0.00 8.17 9.17 Yes 8.17 9.17 0.00
M L 6 7 11 7.50 0.83 0.69 9.17 16.67 Yes 9.17 16.67 0.00
N K,M 8 9 13 9.50 0.83 0.69 16.67 26.17 Yes 16.67 26.17 0.00
Ans A Finish 26.17
Ans A Critical Path CLMN
Ans A Activity Variance 2.75 (Sum of Critical task variances)
Ans 2 M Mean 26.167 Ex time(7,8,9)
S Std Dev 1.658 (sqrt(sum(var(CLMN)))
X Completion 27.000 target
P Probability 0.692 NORM.DIST(X,M,X,TRUE)

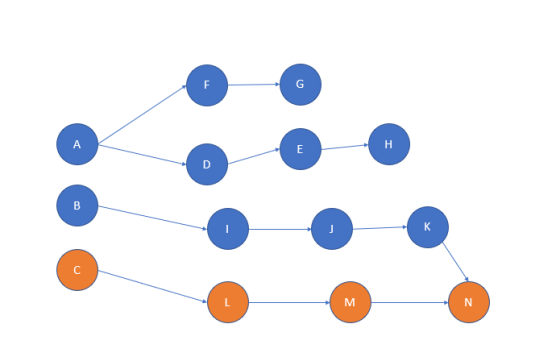

Pert chart:

Orange is Critical path.

Add a comment
Know the answer?
Add Answer to:
at PBI airport. The table aso provides the immedate predecessor event for each activity and the...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • for each problem I have this setup so far. I need help on each part and im not too sure if I am on the right track for each question on the picture. this chapter is on project management for statisti...

    for each problem I have this setup so far. I need help on each part and im not too sure if I am on the right track for each question on the picture. this chapter is on project management for statistics 1. A project is shown by the following network. The durations of activities (in weeks) are indicated on the arrows. a. Identify all of the paths, compute the length of each, identify the critical path and the b. Determine...

  • A project manager discovers that his team has neglected tocomplete the network diagram for the...

    A project manager discovers that his team has neglected to complete the network diagram for the project. the network diagram is shown below. however the project manager has some information available, specifically that each activity a-g, has a different duration between one and seven weeks. also the slack time for each of the activity is known as shown belowDuration (weeks): 1,2,3,4,5,6,7 Slack time (weeks): 0,0,0,1,1,3,7 A D E G B FINISH START C F Using the clues provided below, determine...

  • Consider the following set of activities: Time Predecessor Activity Required Activities A 5 None B 4...

    Consider the following set of activities: Time Predecessor Activity Required Activities A 5 None B 4 A C 5 B D 8 B E 9 C F 6 C,D G 8 D H 3 E,F,G a.     Draw the CPM network for this problem. b.     Calculate and summarize the earliest and latest start and finish times, the slack for each activity, and the critical activities. c.     What is the earliest time that the project can be completed? d.     If the project needed to be completed...

  • Given the information in the following table: Activity Duration Predecessor A 4 None B 6 A...

    Given the information in the following table: Activity Duration Predecessor A 4 None B 6 A C 4 A D 2 C E 4 B F 5 B, D G 3 C H 4 F, G I 2 E, H Construct the (AON) Activity on Node network diagram Find each activity’s ES, EF, LS and LS Identify all paths. Which path is the critical path? Calculate the slack for each activity. How long will it take to complete the project?

  • 1. State whether each of the following statement is true or false. a) The sequence of...

    1. State whether each of the following statement is true or false. a) The sequence of activities in a project is depicted by the precedence (0.5 mark) (0.5 mark) relationships. The critical path is the shortest path through the project network. Slack is the amount of time an activity can be delayed without delaying the project. In PERT, three time estimates (optimistic, most likely and pessimistic) provide an estimate of the mean and variance for each activity based on the...

  • .8-6. A project consists of 12 activities, represented by the project network below, where number by each arc repres...

    .8-6. A project consists of 12 activities, represented by the project network below, where number by each arc represents the duration (in days) of the associated activity 4 12 4 12 10 a) Find the earliest time, latest time, and slack for each event as well as the slack for each activity. Also identify the critical path. (b) The project has been scheduled to be completed in the minimum possible time.If all previous activities have begun as early as possible...

  • Activity Predecessor Optimistic time Most likely time Pessimistic time A - 3 5 8 B -...

    Activity Predecessor Optimistic time Most likely time Pessimistic time A - 3 5 8 B - 4 6 10 C A,B 2 5 8 D B 3 5 9 E A,C 3 6 9 F C,E 1 3 5 G C,D 3 4 9 H D 4 6 10 I F,G 3 4 9 J H 2 4 6 A).Draw the project network b).what is the expected completion time of the project. c) after your calculation, if you find one...

  • 1. Consider the following project. Activity Duration (weeks)5 Immediate Predecessor(s) Cost (S) 1000 | 400 I 20...

    1. Consider the following project. Activity Duration (weeks)5 Immediate Predecessor(s) Cost (S) 1000 | 400 I 200 | 1200 | 500 | 700 | 1200 | 800 | 1800 | 1500 | 400 (a) Construct the activity-on-node (AoN) network for the relations among the activities in the (b) Using the activity-on-node (Ao) network developed in part (a), determine the critical path and the minimum time required to complete the project. Develop the earliest start and finish times, the latest finish...

  • Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A...

    Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A в B C D E, F D G The following table contains the pessimistic, likely, and optimistic estimates for how long activities are estimated to take for Project A. Activity Pessimistic Likely Optimistic 2 5 20 H 16 e. Calculate the time estimates (TE) f. Calculate the variance (s) g. Convert the TE to whole integers and place them in the network diagram for...

  • Consider the network described in the table below. Activity Immediate Predecessor(s) Pessimistic Probable Optimistic J --...

    Consider the network described in the table below. Activity Immediate Predecessor(s) Pessimistic Probable Optimistic J -- 15 10 8 K -- 9 8 7 L J 10 6 5 M J 3 3 3 N K, M 9 5 1 O K, M 10 7 4 P L, N 10 8 3 Draw the network diagram and answer the following questions. (a) Calculate the expected duration of each activity. (b) Calculate the expected duration and variance of the critical path....

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
