Question
Construction methods
Do 4-3

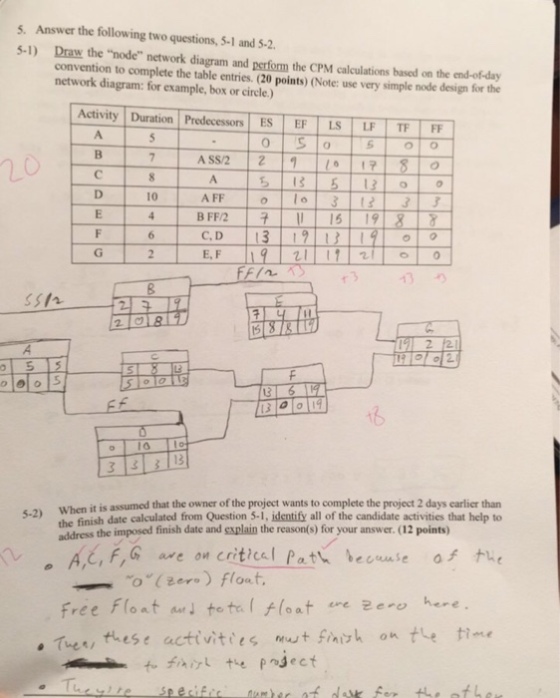

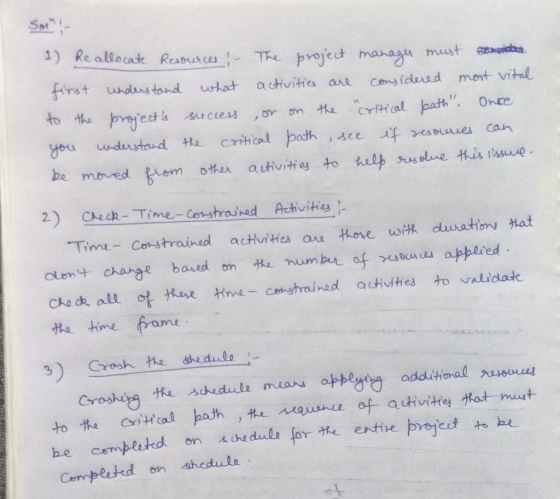

5. Answer the following two questions, 5-1 and S-2 5-1) Draw the node network diagram and perform the CPM calculations based on the end-of-day convention to complete the table entries. (20 points) (Note: use very simple node design for the network diagram: for example, box or circle.) Activity! Duration | Predecessors | EST E-LS 1 LF- B. BFF/2 | 구 | 11 | 15 | 19 E, F SS12 5 13 it is assumed that the owner of the project wants to complete the project 2 days earlier than When the finish date calculated from Question 5-1, identify all of the candidate activities that help to 5-2) sed finish date and explain the reason(s) for your answer. (12 points) address the impo ,Gae on critical Path bense o a. Tue these activities mut siishn te tine
