1)
I)
The manager of a furniture manufacturing plant hopes to achieve a better allocation of inventory control efforts by adopting an ABC approach to inventory control. Given the monthly usages listed below, classify the items in A, B, and C categories according to dollar usage.
|
Annual Usage |
Unit Cost |
|
|
Item Type |
in thousands |
in Dollars |
|
Item 1 |
10 |
$2.50 |
|
Item 2 |
30 |
$1.25 |
|
Item 3 |
20 |
$16.00 |
|
Item 4 |
10 |
$0.75 |
|
Item 5 |
20 |
$3.00 |
|
Item 6 |
33 |
$2.50 |
|
Item 7 |
60 |
$14.25 |
|
Item 8 |
22 |
$10.00 |
|
Item 9 |
100 |
$2.75 |
|
Item 10 |
500 |
$4.25 |
Using the above data, Item 6 will be classified as:
ii) Can you show the formulas and steps for this question
:
A project network is given by the following table. The minimum time required to complete the project is:
|
Activity |
Immediate Predecessors |
Activity Time |
|
A |
- |
5 days |
|
B |
A |
9 days |
|
C |
A |
8 days |
|
D |
B, C |
7 days |
|
E |
C |
4 days |
|
F |
E |
3 days |
|
G |
D, F |
3 days |
i) C) C item
Perform the following operations
Annual Usage in Dollars = Annual Usage in thousands * Unit cost in dollars
Sort the items in descending order of Annual Usage in Dollars
Annual Dollar Usage % of Total = Annual Usage in Dollars / Total
Cumulative % = Running SUM of Annual Dollar Usage % of Total
| Item Type | Annual Usage in thousands | Unit Cost in Dollars | Annual Usage in Dollars (1000) | Annual Dollar Usage % of Total | Cumulative % |
| Item 10 | 500 | 4.25 | 2125 | 53.0% | 53.0% |
| Item 7 | 60 | 14.25 | 855 | 21.3% | 74.4% |
| Item 3 | 20 | 16 | 320 | 8.0% | 82.3% |
| Item 9 | 100 | 2.75 | 275 | 6.9% | 89.2% |
| Item 8 | 22 | 10 | 220 | 5.5% | 94.7% |
| Item 6 | 33 | 2.5 | 82.5 | 2.1% | 96.8% |
| Item 5 | 20 | 3 | 60 | 1.5% | 98.3% |
| Item 2 | 30 | 1.25 | 37.5 | 0.9% | 99.2% |
| Item 1 | 10 | 2.5 | 25 | 0.6% | 99.8% |
| Item 4 | 10 | 0.75 | 7.5 | 0.2% | 100.0% |
| Total | 4007.5 |
Items comprising the last 5% of Total Annual Dollar Usage are classified as C. Item 6 is in the last 5%, hence classified as C item
----------------------------------------------------------------------------------------------------
ii) B) 24 days

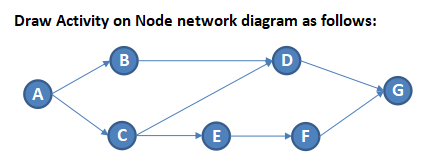

List alternative paths in the network and their duration. Duration of each path is equal to the sum of activity times on that path.
| Path | Duration |
| A-B-D-G | 5+9+7+3 = 24 |
| A-C-D-G | 5+8+7+3 = 23 |
| A-C-E-F-G | 5+8+4+3+3 = 23 |
Path of longest duration is the critical path.
Critical path is A-B-D-G
Minimum time required to complete the project is equal to the time of the critical path, which is 24 days
1) I) The manager of a furniture manufacturing plant hopes to achieve a better allocation of...
Barbara Gordon, the project manager for Web Ventures, compiled a table showing time estimate for each of thecompany's manufacturing activities of a project. The list of activities, immediate predecessors, and estimated times appear in the following table: Activity Immediate Predecessor(s) Time (days) A - 4 B - 6 C - 1 D B 10 E A, D F C 5 G E, F 12 a) Therefore, the critical activities for the manufacturing project are (A - E - G,...
5.) Consider a project whose activities are listed in the table below. Activity A will have slack time as long as… Activity Immediate Predecessors A None B None C A D B E C, D F E G E a. Duration of A < Duration of B b. Duration of A + Duration of C > Duration of B + Duration of D c. Duration of A + Duration of C < Duration of B + Duration of D...
Save Ansv 1 A company must perform a maintenance project consisting of seven activities. The activities, their predecessors and their respective time estimates are presented below Immediate Activity Designation Predecessor Time in Days Break down both machines A None 3 Clean machine 1 B A 3 Clean machine 2 с A 3 Re-set machine 1 D B Re-set machine 2 E с 2. Re-calibrate both machines F D and E Final test F 2 Using CPM what is the Latest...
The following info is available for drawing a PERT network using AOA. *(More than one answer may be selected)* Activity Immediate Predecessors Activity Duration (days) A -- 10 B -- 13 C A 12 D B 15 E A 13 F C 16 G D,E 10 H G,F 5 a. the critical path includes: B, D, G, and H. b. the slack on activity G is not 11 days. c. there is one critical path. d. the total duration to...
Hello, I need help in the following exercises from book: Project Management: Achieving competitive advantage (4th ed.).Jeffery Pinto Exercise 9.1 Consider the following information that you have compiled re- garding the steps needed to complete a project. You have identi- fied all relevant steps and have made some determinations re- garding predecessor/successor relationships. Using MS Project, develop a simple network diagram for this project, showing the links among the project activities. Activity Predecessors A – Survey site — B –...
Earned value calculation Based on the following Project data, answer the questions a and b. Activity Duration Predecessors Task Budget A 7 days -- $16,850 B 10 days -- $22,500 C 8 days B $16,000 D 10 days A $12,790 E 7 days B $8,500 F 4 days D $10,550 At the end of Day 10, the status of the project is as follows. Activity % Complete Actual Cost A 100% $18,000 B 100% $23,000 C 0% $0 D 10%...
Consider the following information about a small project:
b-1.
Identify the critical path.
A. A-D-E-F
b. A-B-C-F
C. A-B-E-F
Identify the earliest
start and finish, and slack for each task. (Leave no cells
blank - be certain to enter "0" wherever required.)
c.
Which of these activities should the project manager track most
closely?
A. A-B-E-F
b. A-D-E-F
c. A-B-C-F
Problem 15.6 Task Duration Estimate (in Days) Immediate Predecessors None А B A B and D E and C Earliest...
QUESTION 1
Part1. The total expected project completion time is:
A. 10 days
B. 11 days
C. 15 days
D. none of the above
Part 2. What is the effect of a delay of 1 day in distributing
tickets?
A. no impact
B. the project will delay by one day
C. the project will delay by more than one day
D. same as the effect of a delay of 1 day in setting up radio
ads
Part 3. What is...
Problem 5-10 The following represents a project that should be scheduled using CPM: IMMEDIATE PREDECESSORS TIMES (DAYS) ACTIVITY a m b A — 1 4 7 B — 3 5 10 C A 2 5 8 D A 4 6 11 E B 1 2 3 F C,D 3 5 7 G D,E 1 2 6 H F,G 2 5 6 b. What is the critical path? B-E-G-H A-D-G-H A-D-F-H A-C-F-H c. What is the expected project completion time? (Round...
Problem 5-10 The following represents a project that should be scheduled using CPM: IMMEDIATE TIMES (DAYS) ACTIVITY PREDECESSORS a m b А 7 B 2 3 7 с A 3 5 7 D А 5 6 10 E B 1 2 6 F CD 1 3 6 DE 1 3 14 H F G 5 14 b. What is the critical path? A-D-G-H B-E-G-H A-D-F-H A-C-F-H c. What is the expected project completion time? (Round your answer to 3 decimal...
