AeroRich, LLC manufactures and installs custom wire harnesses in commercial aircraft. Linda, the project manager, has...

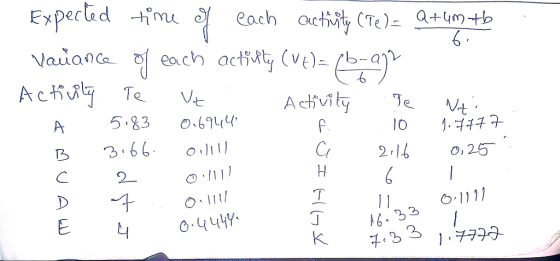

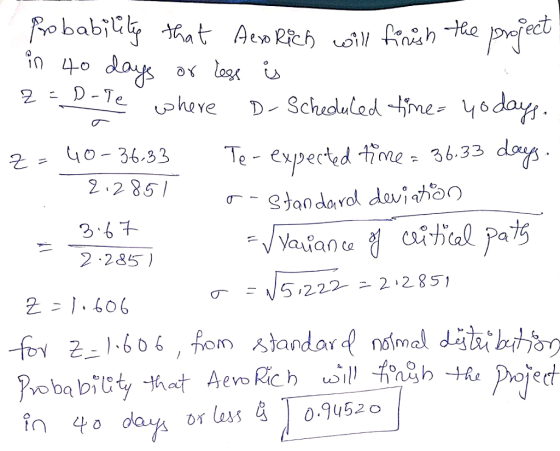

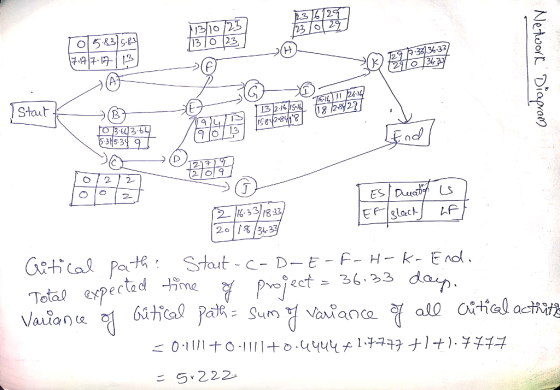

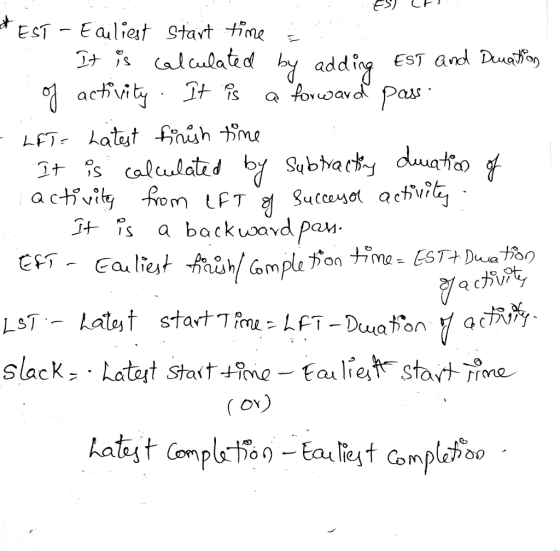

AeroRich, LLC manufactures and installs custom wire harnesses in commercial aircraft. Linda, the project manager, has been very concerned with the amount of time it took to complete several recent jobs. Some of her workers are very unreliable. A list of activities and their optimistic completion time, the most likely completion time, and the pessimistic completion time (all in days) for a new contract are given in the following table. To solve this problem, calculate the expected completion time and variance for each activity, draw a network diagram, complete a forward and backward pass, identify the critical path.What is the probability that AeroRich will finish the project in 40 days or less?

Activity

a

m

b

Immediate predecessor

A

3

6

8

-

B

2

4

4

-

C

1

2

3

-

D

6

7

8

C

E

2

4

6

B,D

F

6

10

14

A,E

G

1

2

4

A,E

H

3

6

9

F

I

10

11

12

G

J

14

16

20

C

K

2

8

10

H,I

0 0
Add a comment Improve this question Transcribed image text
Know the answer?
Add Answer to:
AeroRich, LLC manufactures and installs custom wire harnesses in commercial aircraft. Linda, the project manager, has...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Kelle Carpet and Trim installs carpet in commercial offices. Peter Kelle has been very concerned with...

    Kelle Carpet and Trim installs carpet in commercial offices. Peter Kelle has been very concerned with the amount of time it took to complete several recent jobs. Some of his workers are very unreliable. A list of activities and their optimistic completion​ time, the most likely completion​ time, and the pessimistic completion time​ (all in​ days) for a new contract are given in the following​ table: Activity: a,b.c.d.e.f.g.h.i.j,k Time.(Days ) A, M, B, predecessors A= 2, 5, 9, zero B=...

  • uction needs to complete construction of Shopping Mall project, which is start in August. They are...

    uction needs to complete construction of Shopping Mall project, which is start in August. They are concerned with the completion time. Some of the ighly unreliable. List of activities and their optimistic, pessimistic, and most ion times in weeks) are given in following table: Optimistic Most Likely Pessimistic E(t) 3 5 9 13 11 0.1111 2.7778 7 Immediate Predecessor(s) None A None None AC D, E D, E F G F DF 2 6 9 5 10 6 5 2...

  • It was determined on the following project that the duration for the tasks contained some uncertainty....

    It was determined on the following project that the duration for the tasks contained some uncertainty. After more research, the optimistic and pessimistic values were determined. 1. a. Calculate the expected time and variance (using the 95 percent level of confidence) for each activity. b. Determine the critical path and time for completion c. Calculate the probably that the project will finish in 30 days. Calculate the probably of completing the project in 27 days. Other than the critical path,...

  • Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A...

    Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A в B C D E, F D G The following table contains the pessimistic, likely, and optimistic estimates for how long activities are estimated to take for Project A. Activity Pessimistic Likely Optimistic 2 5 20 H 16 e. Calculate the time estimates (TE) f. Calculate the variance (s) g. Convert the TE to whole integers and place them in the network diagram for...

  • QUESTION 1 G E. H. C A Finish Start D. Complete the network activity diagram using the table below to answer questio...

    QUESTION 1 G E. H. C A Finish Start D. Complete the network activity diagram using the table below to answer questions 1-15. The expected activity completion times are provided in days. Each question is 1 point. Most Probable Activity Optimistic Pessimistic A 7 B 12 C 5 12 7 E 10 15 20 6 9 18 G 6 13 H 11 What is the early start (ES) time for activity F? 13 12 10 None of the above are...

  • A small software development project has eight major activities. The times are estimated and prov...

    A small software development project has eight major activities. The times are estimated and provided in the table below: Activity Optimistic Time Most Likely Time Pessimistic Time Immediate Predecessor(s) A 3 4 5 -- B 5 7 9 -- C 2 3 10 A D 2 5 8 B E 1 7 7 B F 3 5 7 C, D G 7 8 9 D, E H 2 6 10 F Answer the following questions based on above table 1-2...

  • Consider the following network for a small maintenance project (all times are in days). [7 Marks]...

    Consider the following network for a small maintenance project (all times are in days). [7 Marks] Activity Immediate Predecessor [s] Optimistic Time Most Likely Time Pessimistic Time A - 2 3 4              B - 5 6 7 C - 5 6 7 D A 3 4 5 E A 2 3 4 F C 3 4 5 G C 8 10 16 H B, E, F 5 6 7 I B, E, F 7 11 15 J B, E,...

  • You are responsible for managing a project with the following activities (all times are given in...

    You are responsible for managing a project with the following activities (all times are given in weeks): Optimistic Most Likely Pessimistic Immediate Time Predecessor(s) Time Activity Time 4 C, D D, E 12 4 8 6 4 What is the expected time of completion of the project? (weeks) (Include 1 decimal place, e.g.,3.1.) abs What is the probability that the project will be completed in 24 weeks or less? (Provide ab 2 decimal places, no 90 sign, e.g., 2.12 for...

  • Activity Predecessor Optimistic time Most likely time Pessimistic time A - 3 5 8 B -...

    Activity Predecessor Optimistic time Most likely time Pessimistic time A - 3 5 8 B - 4 6 10 C A,B 2 5 8 D B 3 5 9 E A,C 3 6 9 F C,E 1 3 5 G C,D 3 4 9 H D 4 6 10 I F,G 3 4 9 J H 2 4 6 A).Draw the project network b).what is the expected completion time of the project. c) after your calculation, if you find one...

  • Coleman Rich Control Devices, Inc., produces custom-built relay devices for auto makers. The most recent project...

    Coleman Rich Control Devices, Inc., produces custom-built relay devices for auto makers. The most recent project undertaken by Rich requires 14 different activities. Rich's managers would like to determine the total project completion time (in days) and those activities that lie along the critical path. The appropriate data are shown in the following table: பா் Immediate Immediate Time (days) Time (days) Predecessor(s) Activity Predecessor(s) b b Activity a 6 E, F G, H A 4 5 8 3 3 B...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
