Prepare a cost exhibit showing cumulative cost by time period for the project shown below.
|
Activity |
Immediate Predecessors |
Duration |
Activity Budget Cost |
|
1.0 |
4 |
1,000 |
|
|
2.1 |
1.0 |
3 |
6,000 |
|
2.2 |
1.0 |
4 |
5,000 |
|
2.3 |
1.0 |
2 |
1,500 |
|
3.0 |
2.1 |
4 |
3,200 |
|
4.0 |
2.2 2.3 |
3 |
4,800 |
|
5.0 |
3.0 4.0 |
4 |
800 |
|
6.1 |
5.0 |
3 |
7,200 |
|
6.2 |
5.0 |
2 |
1400 |
|
6.3 |
5.0 |
1 |
1,200 |
|
7.0 |
6.1 6.2 6.3 |
2 |
2,100 |

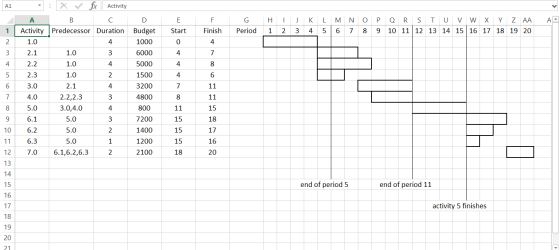

Let's create the table and the gantt chart first

a)
At the end of period 5 the budgeted cost should cover
100% completion of activity 1.o
33.3% completion of activity 2.1
25% completion of activity 2.2
50% completion of activity 2.3
Thus the budgeted cost is 1000 + (1/3)*6000 + (1/4)*5000 + (1/2)*1500 = 5000
b)
At the end of period 11 the following is budgeted to be completed. Activities 1.0, 2.1, 2.2, 2.3, 3.0, and 4.0. Thus the total cost is 21500
c)
Activity 5 is supposed to finish at the end of period 15. This means the budgeted cost of work scheduled is 22300 at this point. However, if it takes additional 1 period then it will complete at end of period 16.
Budgeted cost of work scheduled (BCWS) at the end of period 16 is
22300 + (1/3)*7200 + (1/2)*1400 + 1200 = 26600
However, the Budgeted cost of work performed (BCWP) is only till activity 5. That means it is 22300.
The formula for schedule variance is
SV = BCWP – BCWS = 22300 – 26600 = -4300
d)
Actual cost of work performed (ACWP) incurred is 22300+300 = 22600
The formula for cost variances
CV = BCWP – ACWP = 22300 – 22600 = -300
