Question

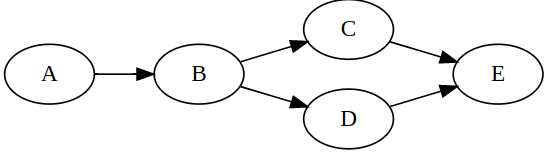

From the following information, develop an AON project network. Complete the forward and backward pass, compute...

From the following information, develop an AON project network. Complete the forward and backward pass, compute activity slack, and identify the critical path. How many days will the project take? ID Description Predecessor Time A Survey site None 3 B Excavate site A 5 C Install power lines B 2 D Install drainage B 5 E Pour foundation C, D 4 The project will take _ days. The critical path is _ The late start on Activity C is _ days. The slack on Activity C is _ days. The slack on Activity D is _ days. The early start on Activity E is _ days.

0 0
Add a comment Improve this question Transcribed image text
Answer #1

ACTIVITY

DURATION

ES

EF

LS

LF

SLACK

A

3

0

3

0

3

0

B

5

3

8

3

8

0

C

2

8

10

11

13

3

D

5

8

13

8

13

0

E

4

13

17

13

17

0

FORWARD PASS = ES = MAX EF OF THE PREDECESSOR

EF = ES + DURATION

BACKWARD PASS = LF = MIN LS OF ALL SUCCESSORS

LS = LF - DURATION

CRITICAL PATH = PATH WITH LONGEST DURATION AND 0 NET SLACK

CRITICAL PATH & DURATION

A + B + D + E = 17


Add a comment
Know the answer?
Add Answer to:
From the following information, develop an AON project network. Complete the forward and backward pass, compute...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • 3. Using the project information below, draw the AON diagram, complete forward and backward pass, and...

    3. Using the project information below, draw the AON diagram, complete forward and backward pass, and identify the critical path. (10 points) Activity Duration Network relationships A-D Finish to Start A C Finish to Start A - B Start to Start - Lag 2 time units D E Start to Start - Lag S time units D-E Finish to Finish - Lag 1 time unit B E Finish to Start C-F Finish to Start - Lag 5 time units E...

  • Please use the information below to draw and solve the network on a piece of paper...

    Please use the information below to draw and solve the network on a piece of paper by: • Complete the forward and backward pass • Identify the critical path Fill in the requested information (Example: ESA - Early Start of Activity A; LFA - Late Finish of Activity A, etc) Duration 3 Predecessor Relationship N 2 - Activity Activity ID Contract sign A Survey Target market C Data collection Presentation Analyze results Demographics G Closing H FS Lag 3 N...

  • Hello, I need help in the following exercises from book: Project Management: Achieving competitive advantage (4th...

    Hello, I need help in the following exercises from book: Project Management: Achieving competitive advantage (4th ed.).Jeffery Pinto Exercise 9.1 Consider the following information that you have compiled re- garding the steps needed to complete a project. You have identi- fied all relevant steps and have made some determinations re- garding predecessor/successor relationships. Using MS Project, develop a simple network diagram for this project, showing the links among the project activities. Activity Predecessors A – Survey site — B –...

  • QUESTION 1 Please use the information below to draw and solve the network on a piece...

    QUESTION 1 Please use the information below to draw and solve the network on a piece of paper by: Complete the forward and backward pass Identify the critical path Fill in the requested information (Example: ESA Early Start of Activity A; LFA Late Finish of Activity A, etc) Relationship Activity Contract sign Predecessor Activity ID Duration 3 А Survey В 2 А Target market C Data В,С D 7 collection Presentation 2 FS Lag 3 E В Analyze F 2...

  • Write an Essay that exceeds 500 words following the APA 6th edition on the network diagram...

    Write an Essay that exceeds 500 words following the APA 6th edition on the network diagram and its benefit to the project. Address the following: What is the Network Diagram? Describe the "Activity on Node" and "Activity on Arrow" diagram. What is an early and late start, early and late finish? Describe forward and backward pass. What is slack or float? Explain the critical path. Please use a minimum of 2 references.

  • Please help with 1-2!! Network diagram: Exercise # 4 Based on Excercise 3 from Module 6: 1. Perform a Forward...

    Please help with 1-2!! Network diagram: Exercise # 4 Based on Excercise 3 from Module 6: 1. Perform a Forward Pass and a Backward Pass of the network diagram above 2. Which Activities has the same Early Finish as they have Late Finish? Note: The project starts on Day "O" Early Start Duration Early Finsh Task Name Late Start Late Finish Slack A 2. 2 6 4 H Exercise # 4 Based on Excercise 3 from Module 6: 1. Perform...

  • Assignment for week 5 Given the following information, draw the project network

    Assignment for week 5Given the following information, draw the project network. Compute the early, late and slack times for the project network. which activities are on the critical path have only the start or finish of the activity on the critical path?ID duration finish to start finish to start additional lag lag predecessor lag Relationship A 2 none 0 none 0B 4 A 0 none 0C 6 A 0 finish-finish C to F 7D 8 A 0 none 0E 18...

  • 1. For the following schedule, Draw the AON network diagram for the project and calculate the...

    1. For the following schedule, Draw the AON network diagram for the project and calculate the schedule. а. Summarize the schedule in a tabular form, showing ES, EF, LS, LF, TF, and FF for each activity b. Denote the critical path on the network. C. d. Perform a cost analysis based on an early start, late start, and target schedule for the project. Plot the cumulative cost distribution for the three S-curves on one graph. e. f. Plot the cumulative...

  • 8. You have signed a contract to build a garage for the Simpsons. You will receive...

    8. You have signed a contract to build a garage for the Simpsons. You will receive $500 bonus for completing the project within 17 working days. The contract also contains a penalty clause in which you will lose $100 for each day the project takes longer than 17 working days. Draw a project network given the information below. Complete the forward and backward pass, compute the activity slack, and identify the critical path. Do you expect to receive a bonus...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
