7. The correct answer is C
Since in PERT diagram precedent and subsequent relationships are to be identified for all activities.
8. To identify critical path, we first need to find no. Of days required to complete for all possible paths. So possible paths are:
A-B-D-F=1+3+2=6
A-C-E-F=3+1+3=7
A-C-B-D-F=3+3+3+2=11
A-B-D-E-F=1+3+2+3=9
A-C-B-D-E-F=3+3+3+2+3=14
Since the maximum time is on pathA-C-B-D-E-F i.e 14 days. The correct answer is E
9. The correct answer is B
Since gantt chart is a bar diagram illustrating project schedule named after its inventor Henry Gantt.
Gantt chart is a bar chart with project activities on the left hand side and units of time across the top.
10. The correct answer is D
Since gantt chart helps to plan the entire schedule and progress of the project by showing relationship among project activities.
11 The correct answer is B
During feasibility analysis, under operational feasibility, change and resistance from employees is being taken care of.
Do give your feedback! Happy learning :) :)

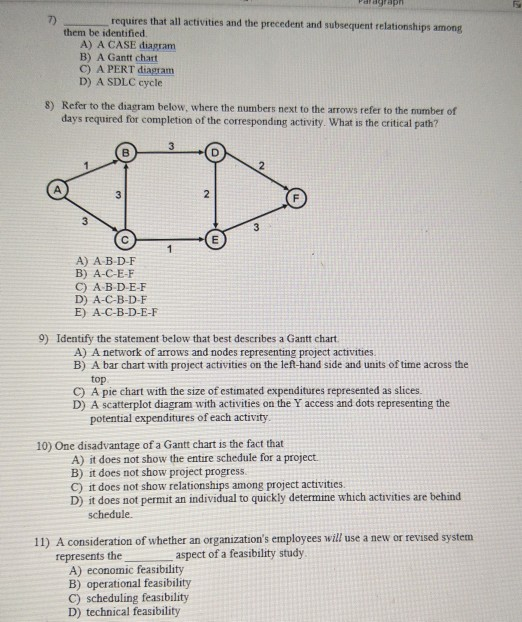

Palayan requires that all activities and the precedent and subsequent relationships among them be identified A)...
Please draw the Gantt chart for the project. Use different
color for critical path activities and non-critical path
activities. Use arrows to indicate the slack time on the Gantt
chart. (1 point)
Note: if you use Excel or other graphical tools to create the
Gantt chart, you may submit the files separately.
YOUR SCORE: TOTAL POINTS: 5 Question (a), (b) and (e) are related to Lecture 17. Questions (c) and (d) are related to Lecture 18 The activity information and...
Select all false statements. A. One way that project management differs from management of more traditional activities is the limited scale of activities. B. A Gantt chart is used to display precedence relationships. C. PERT and CPM are nearly identical in terms of analysis and procedures. D. The main function of dummy activities is to clarify relationships in network diagrams. E. The total cost of crashing any one activity should never exceed 50 percent of the total cost of the...
please answer this problem
Answer all questions Consider a project consisting of 12 activities and their duration along with precedence as follows: Activity Precedence Duration (Days) B,C D,F.H IJ 10 5 marks Questionl Analyze the critical path to determine the total duration for the completion of the project Question2: Compute slack time for each task and analyze the appropriateness of the slack time and its usage in the process [5 marks] [5 marks Question3: Determine appropriate technological solution for the...
3. (20 points) A landscaping upgrade project consists of following activities. Times are given in weeks. Activity | Immediate Predecessor Activity Time A А ထင်ထ F B, DC D D 3 3 a. Draw the network diagram and find the ES, EF, LS, LF, and slack for each activity b. Construct an early-start-date Gantt chart for the project. C. As a project manager, where would you focus your attention, given your analysis?
I need help with the following problem. Schedule the following activities using CPM. ACTIVITY Immediate Predecessors Time in Weeks A ---- 2 B A 5 C A 4 D B 3 E C, D 6 F D 3 G F 3 H E, G 4 Draw the network diagram below using the square activity I have provided. Just select the object, then copy it and paste how many you need and then arrange them in the order you need and...
Given the following Project Activities and Precedence Relations table; determine the Critical Path, and the minimum Project Duration. Create the Gantt Chart for the project represented in the table. Project Activities and Precedence Relations ACTIVITY DURATION PRECEDED BY: А 3 B 2 A C 2 1 D E 1 B F 2 1 D D G H 4 2 BD E J 1 E F 4 K L 3 G M N 3 3 H 0 4 HKL P MNO...
Given the following Project Activities and Precedence Relations table; determine the Critical Path, and the minimum Project Duration. Create the Gantt Chart for the project represented in the table. Project Activities and Precedence Relations ACTIVITY DURATION PRECEDED BY: A 3 B 2 A C 2 D 1 E 1 B F G 2 1 D D H 4 BD 2 J J 1 4 K F L 3 G M N 3 3 IJ H 0 4 HKL MNO Р...
. Verizon LTE 1:22 PM 10 77% 3. It is common for activities in projects to run late. What should be DONE when this happens differs between traditional Critical Path Method (CPM) and TOC's Critical Chain Project Management (CCPM). The upper-most of the two diagrams provided below is a typical Critical Path Method (CPM) Gantt PERT Chart schedule. The lower of the two diagrams is a typical Critical Chain Project Management (CCPM) schedule (with resource, feeding and project buffers included)....
ASSIGNMENT- Scheduling a. Draw the EARLY start Gantt chart and state the critical activities b. Draw the LATE start Gantt chart c. Draw the AON chart - Forward pass d. Draw the AON chart - Backward pass e. Identify the critical path from the table (follow ppt/notes) MUST BE DONE NEATLY! ACTIVITY WEEKS PRECEDENCE A B с D E F 3 4 5 7 2 4 3 A B B E C,D GF H
The following activities of a hospital expansion project has been identified in the following table. First, all activities of the project are listed. Next, the immediate predecessor(s) of each activity is identified (activity relationships). Please plot the activity network diagram and answer the following questions. Hospital Expansion Project Activity Description Immediate predecessor(s) Activity Time (Weeks) A Select administrative and medical staff - 12 B Select site and do site survey - 9 C Select equipment A 10 D Prepare final...
