Question

8. The following project network and associated costs are given (T in days, C in $1,000s) Normal Crash Cost Slope Activity 12 4.5 10 16 10 10 (a) Compute the cost slopes. What is the earliest the project can be completed under normal conditions? What is the direct cost? 2 days? What is the project cost? way of doing this? What is the project cost? (b) What is the least costly way to reduce the project completion time by (c) What is the earliest the project can be completed and what is the least costly 281 Chapter 7 Advanced Project Network Analyses and Scheduling Please i want a simple and clear solution like someone will solve it on a paper not excel

0 0
Add a comment Improve this question Transcribed image text
Answer #1

Solution :

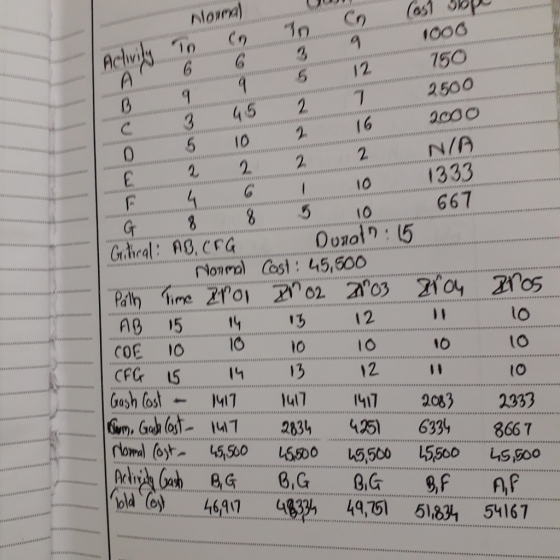

A : Cost slopes as in image below. Normal duration : 15 and Cost : 45,500

B : To reduce duration by 2 days crash activity B, G twice. Project Cost : 48,334

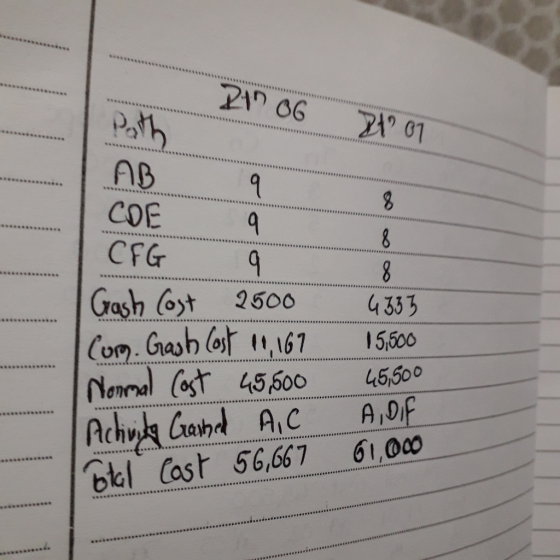

C : Earliest project duration : 8 days and cost : 61,000

Add a comment
Know the answer?
Add Answer to:
Please i want a simple and clear solution like someone will solve it on a paper...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Given below is the crashing data for a project along with other data. The project completion...

    Given below is the crashing data for a project along with other data. The project completion time is 20 davs. Determine: (a) the crash slope (i.e crash cost/day) for all activities, (b) the normal total project cost, (c) prioritized the list of activities for crashing from best to worst, (d) the best activity to crash if the project has to be completed in 19 days and alternative critical paths, if any, (e) the earliest time the project can be completed,...

  • Question 18 What are the two principles when crashing a project? Focus on the critical path,...

    Question 18 What are the two principles when crashing a project? Focus on the critical path, select the least expensive alternative. Reduce the cost, reduce the duration. Reduce the duration, increase the cost. Reduce the use of resources, reduce the cost 4 points Question 19 The formula for computing the cost/time slope for each activity that can be crashed is . (Crash cost + Normal cost) / (Crash time + Normal time) (Crash cost - Normal cost) / (Crash time...

  • A manufacturer of personal computers has recently identified time estimates, activities and predecessors to design, manufacture...

    A manufacturer of personal computers has recently identified time estimates, activities and predecessors to design, manufacture and market a new laptop computer. Their estimates are listed below Immediate Activity Description Estimated completion time (days) 90 15 Predecessors Prototype design Purchase of materials Manufacture of prototype Revision of design Initial production run Staff training Staff input on prototype Sales training Preproduction advertising campaign Post production advertising campaign 20 21 25 14 28 30 C,F D,I Management has also provided you with...

  • Past Paper (Q2) 1. What are examples of quality prevention, appraisal and failure costs. (5 marks)...

    Past Paper (Q2) 1. What are examples of quality prevention, appraisal and failure costs. (5 marks) 2. Discuss possible reasons for reducing project duration. Discuss the options that are available for accelerating project completion (5 marks) 3. Consider the following information. a. Draw the project network and determine the critical path for the network. (3 marks) b. Compute the duration that represents the lowest total project cost. (10 marks) c. What is this cost? (2 marks) (Note: You may find...

  • Use the information contained below to compress one time unit per move using the least cost...

    Use the information contained below to compress one time unit per move using the least cost method. Reduce the schedule until you reach the crash point of the network. For each move identify what activity(ies) was crashed and the adjusted total cost. (i.e., Calculate the minimum direct cost when project is finished in 13 days, 12 days, 11 days, as well as 10 days.) Note: Choose B instead of C and E (equal costs) because it is usually smarter to...

  • TYPE: A CRAMOCerat Managmenti Sume 20t9 2 JCh. 3. Project Management] Jacksonville Bike Shop is behind...

    TYPE: A CRAMOCerat Managmenti Sume 20t9 2 JCh. 3. Project Management] Jacksonville Bike Shop is behind on a custom bike and needs to crash 1 day of time from the 6-step project. Given the project table below answer the following questions. Suppose this shop calls the customer and asks for a project extension, reducing the amount of time she/he nceds to crash. [Note: The project can be speeded up (or "crashed") by spending For example, activity A currently takes 10...

  • Solve the following project crashing problem adopted from Heizer et al. (2016). Attempt the question before looking up the solution on Page 855 of Heizer et. al. 2016 3.32Kimpel Products makes pi...

    Solve the following project crashing problem adopted from Heizer et al. (2016). Attempt the question before looking up the solution on Page 855 of Heizer et. al. 2016 3.32Kimpel Products makes pizza ovens for commercial use. James Kimpel, CEO, is contemplating producing smaller ovens for use in high school and college kitchens. The activities necessary to build an experimental model and related data are given in the following table: NORMAL CRASH TIME TIME NORMALI CRASH! IMMEDIATE ACTIVITY (WEEKS) (WEEKS) COST...

  • 1. When finding the approximate probability of project duration, it is necessary to know which of...

    1. When finding the approximate probability of project duration, it is necessary to know which of following? a. The mean and variance of each activity b. The mean of each activity on the CP c. The sd of only the activities on the CP d. Each activity's probability of completion e. The distribution of activity times 2. The sd of a path is computed as: a. the sum of the sd of all activities on the path b. the square...

  • A manufacturer of personal computers has recently identified time estimates, activities and predecessors to design, manufacture and market a new laptop computer. Their estimates are listed...

    A manufacturer of personal computers has recently identified time estimates, activities and predecessors to design, manufacture and market a new laptop computer. Their estimates are listed below Immediate Activity Description Estimated completion time (days) 90 15 Predecessors Prototype design Purchase of materials Manufacture of prototype Revision of design Initial production run Staff training Staff input on prototype Sales training Preproduction advertising campaign Post production advertising campaign 20 21 25 14 28 30 C,F D,I Management has also provided you with...

  • QUESTION 1 Part1. The total expected project completion time is: A. 10 days B. 11 days...

    QUESTION 1 Part1. The total expected project completion time is: A. 10 days B. 11 days C. 15 days D. none of the above Part 2. What is the effect of a delay of 1 day in distributing tickets? A. no impact B. the project will delay by one day C. the project will delay by more than one day D. same as the effect of a delay of 1 day in setting up radio ads Part 3. What is...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
