The expected times and variances for the project activities follow. Complete the table showing which activities are critical
0 1
Add a comment Improve this question Transcribed image text
✔ Recommended Answer
Answer #1

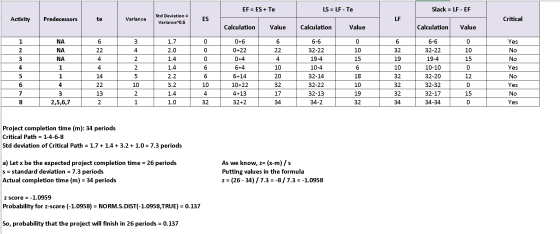

EF = ES + Te LS = LF - Te Slack = LF - EF Activity Predecessors te Variance Std Deviation = Variance^0.5 ES LF Critical Calcu

Add a comment
Know the answer?
Add Answer to:
The expected times and variances for the project activities follow. Complete the table showing which activities...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Similar Homework Help Questions
  • A7-3 (Algo) The expected times and variances... The expected times and variances for the project activities...

    A7-3 (Algo) The expected times and variances... The expected times and variances for the project activities are given below. Complete the table showing which activities are critical ID 1 Pilot production 2 Select channels of distrib 3Develop mktg. program 4Test market 5 Patent 6 Full production 7 Ad promotion 8Release Description Predecessor None None None Variance Critical? te 6 40 18 4 15 4 16 2,5,6,7 What is the probability of completing the project in 29 periods? (Do not round...

  • A7-3 (Algo) The expected times and variances... The expected times and variances for the project activities...

    A7-3 (Algo) The expected times and variances... The expected times and variances for the project activities are given below. Complete the table showing which activities are critical ID Description Predecessor te Variance Critical? 1 2 3 None Pilot production Select channels of distrib. Develop mag program Test market None 4 5 Patent 6 Full production Ad promotion Rese What is the probability of completing the project in 32 periods? Hint Use the ENORM S DISTI, TRUE) function in Excel to...

  • A7-3 (Static) The expected times and variances... The expected times and variances for the project activities...

    A7-3 (Static) The expected times and variances... The expected times and variances for the project activities are given below. Complete the table showing which activities are critical ID Description Predecessor te Variance Critical? None None 1 2 3 4 Pilot production Select channels of distrib. Develop mktg, program Test market None 5 Patent 6 Full production 7 8 Ad promotion Release 25.6.7 What is the probability of completing the project in 25 periods? Hint: Use the ENORM.S.DISTZ, TRUE) function in...

  • 4. For the following project, the expected times and variances for the project activities are given....

    4. For the following project, the expected times and variances for the project activities are given. a. Draw the AON diagram. b. What is the probability of completing the project in 30 time periods? (10 points) Activity ID Predecessor ariance [(b-a)/6) 4 1 2 Naluna 2, 5, 6, 7 Z Value Probability Z Value Probability +0.0 9893

  • Given the project information in the following table, what is the probability of completing the National...

    Given the project information in the following table, what is the probability of completing the National Holiday Toy project in 98-time units? Hint: Use the =NORM.S.DISTIZ, TRUE) function in Excel to compute the probability (Carry at least 3 decimal places in all intermediate calculations and the Z value. Enter your final probability answer to 3 decimal places.) (b) Acet. ID 1 2 3 4 5 6 7 Description Design package Design product Build package Secure patent Build product Paint Test...

  • Data regarding the activities for a project are presented below. The times are in weeks. The...

    Data regarding the activities for a project are presented below. The times are in weeks. The critical path for this project is A - D - H - I - J - K. Activity Optimistic Time Most Likely Time Pessimistic Time A 7 9 14 B 2 2 8 C 8 12 16 D 3 5 10 E 4 6 8 F 6 8 10 G 2 3 4 H 2 2 8 I 6 8 16 J 4 6...

  • (50 points) Data regarding the activities for a project are presented below. The times are in...

    (50 points) Data regarding the activities for a project are presented below. The times are in weeks The critical path for this project is A-D-H-I-J-K 2. Pessimistic Time Most Likely Time y Optimistic Time 8 16 10 8 10 12 8 14 5 6 2 a. Determine the standard deviation of the critical path. b. Determine the probability of completing the project in 38 weeks or less c What is the probability of completing the project in 32 weeks or...

  • project are listed for a In the following table the activities with their precedence sequence and...

    project are listed for a In the following table the activities with their precedence sequence and expected time (days) Immediate Predecessor(s) Time (days) Activity 7 A 2 A B 4 C 4 5 5 E C F 2 G E, F 3 H G, H a) The activities on the critical path are b) The project length is days.

  • The estimated times and immediate predecessors for the activities in a project at Caesar Douglas’s screening...

    The estimated times and immediate predecessors for the activities in a project at Caesar Douglas’s screening company are given in the following table. Assume that the activity times are independent. All times are in weeks. Activity Predecessors Optimistic Time (a) Most Likely Time (m) Pessimistic Time (b) A -- 9 10 11 B -- 4 10 16 C A 9 10 11 D B 5 8 11 What is the critical path based on expected times? You may use any...

  • The following table represents the set of activities required to complete a project, along with their...

    The following table represents the set of activities required to complete a project, along with their time estimates for PERT calculations. a. Using the data in the table, calculate the expected time (ET) and variance for each activity. Job number Predecessor Job(s) a m b expected time (ET) variance A --- 3 5 7 B A 3 4 5 C A 2 3 4 D B 3 4 11 E B,C 4 9 14 F D, E 6 8 10...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
