Solution:

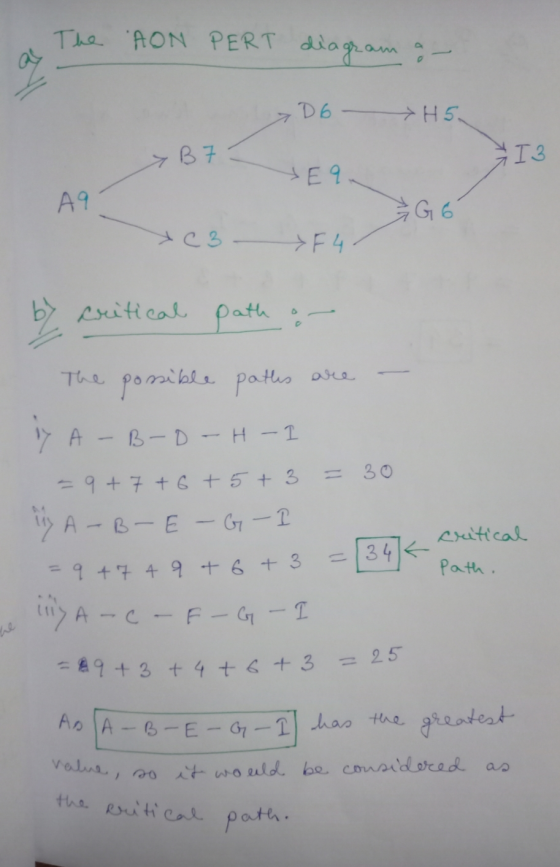

To solve the problem 3.12, it is first needed to draw the AON PERT diagram with the help of the activities. The possible paths can be calculated from the AON PERT diagram. From the diagram, three possible paths can be drawn. The critical path can be calculated based on the values. The path with the greatest value can be taken as the critical path.

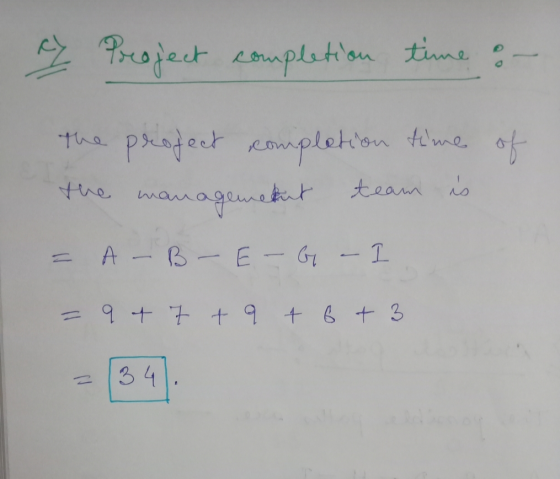

The project completion time is calculated based on the time of the critical path which is 34.

Hope this helps :)
Please let me know if you have any doubt. Thanks.
