Question
please answer question 3 with complete answers and explanations. Typed only thank you

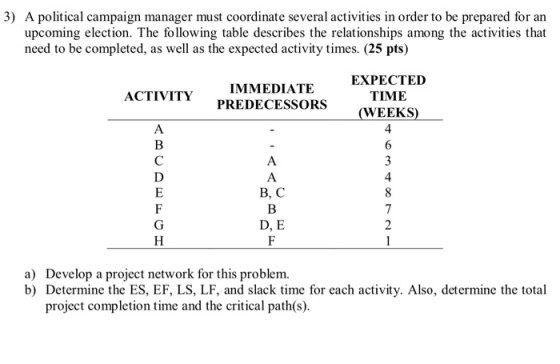

3) A political campaign manager must coordinate several activities in order to be prepared for an upcoming election. The foll
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Critical path method (CPM) is a step-by-step process by which critical and non-critical tasks are defined so that time-frame problems and process bottlenecks are prevented.

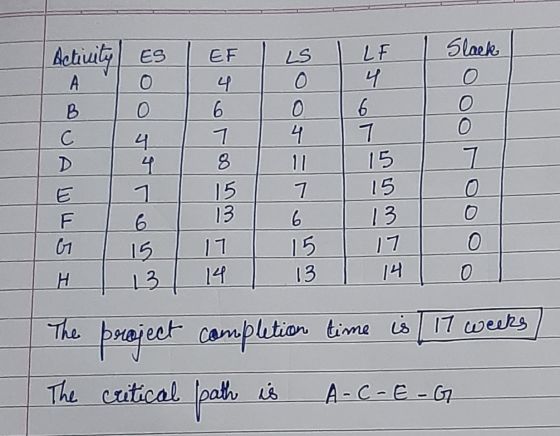

ES Activitu EF LS Time LF ES= marcineum (EF of all immediate bredecessor) EF= ES + duration LF = minimum (Ls of all immediate

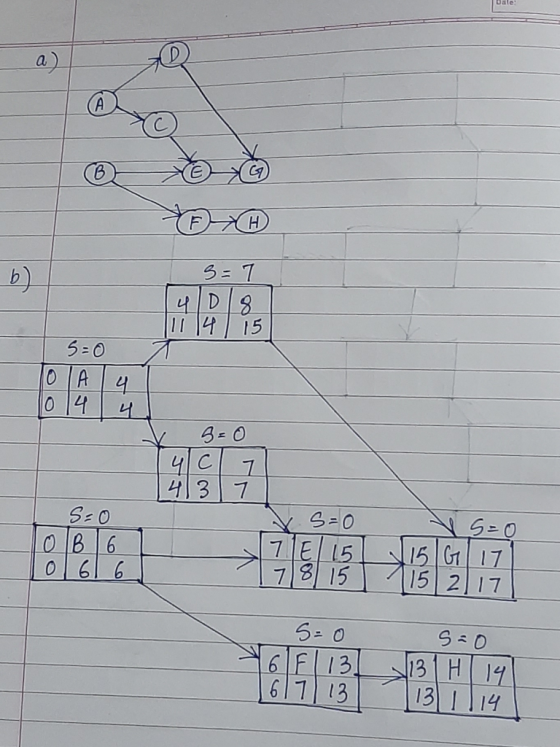

Dale og ☺ ☺ I 9=7 Ti 14 15 T 50 TOTA 4 To 144 3= 0 S=0 OB 6 0616 7 E 15 78 15 17 15 117 S=0 sao 6E 130 131H 141 161713 13 111Activity ES | EF ILS I LE Slack B 0 6 o 74 7 8 11 15 7 I 15 T 6 I 13 I 1517 15 I 17 13 14 13 14 O The project completion time

Add a comment
Know the answer?
Add Answer to:
please answer question 3 with complete answers and explanations. Typed only thank you 3) A political...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Please show me the answer and how to place it on a spreadsheet. Thanks. 13.7 Table...

    Please show me the answer and how to place it on a spreadsheet. Thanks. 13.7 Table EX 13.7 shows the precedence relationships among the activities to complete a project. Table EX 13.7 Activity Predecessor Duration (Weeks) A – 6 B – 2 C A 4 D B 5 E B 2 F C, D 4 G C, D 7 H E, G 5 I F 4 Construct an activity on node network for the project. Identify the paths and path...

  • I need Activity A-H Myo Dave Fletcher was able to determine the activity times for constructing...

    I need Activity A-H Myo Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for each activity. The total project completion time and the critical path should also be determined. Here are the activity times: Time Immediate TimeImmediate Activity (weeks) Predecessorís) Activity (weeks) Predecessors) G 10 C, E D. F Dae'sarlest start (ES) and eariest fnish (EF) are

  • question 3.12 Chapter 3 Project Management 91 Table for 3.8 Time Activity Immediate Code Description in...

    question 3.12 Chapter 3 Project Management 91 Table for 3.8 Time Activity Immediate Code Description in hours) Predecesur Planning Find location determine resource requirements Purchasing Requisition of lumber and sand Excavation Planning Dig and grade Sawing Planning Saw lumber inte appropriate sizes Placement Purchasing Position lumber in comect locations Sawing. c om Assembly Nail lamber together Placement Tafill Put sand in and under the equipment Ambly Outfill Put dirt a nd the equipment Assembly Decoration Put grass all over the...

  • also needs daves latest start and latest finish: Dave Fletcher was able to determine the activity...

    also needs daves latest start and latest finish: Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for e activity. The total project completion time and the critical path should also be determined. Here are the activity times: Activity Time (weeks) Immediate Predecessor(s) Activity Time (weeks) Immediate Predecessor(s) C, E D, F Dave's earliest start (ES) and earliest finish (EF) are: Activity ES...

  • Tom Schriber, a director for personnel of Management Resources, Inc., is in the process of designing...

    Tom Schriber, a director for personnel of Management Resources, Inc., is in the process of designing a program that its customers can use in the job-finding process. Some of the activities include preparing resumes, writing letters, making appointments to see prospective employers, researching companies and industries, and so on. Some of the information on the activities is shown in the following table: Days Immediate Predecessors Activity a m b A 8 9 10 __ B 6 7 8 __ C...

  • The ABC Manufacturing Co. has made a decision to replace an existing production line with new...

    The ABC Manufacturing Co. has made a decision to replace an existing production line with new equipment. This project will require several tasks (jobs) with precedence relationships and duration (days) as shown in the following table. The project will be finished when activities A-J are all finished. Activity predecessor Optimistic Most likely Pessimistic Expected A - 4 5 12 B A 3 4.5 15 C A 2 3 4 D C 6 8 22 E B 4 6 8 F...

  • Provide step by step please thank you, no exce Assume you have a project with ten...

    Provide step by step please thank you, no exce Assume you have a project with ten activities labeled A-J, as shown. Derive the earliest completion time (or early finish-EF), latest completion time (or late finish-LF), and slack for each of the following tasks (begin at time 0) the critical path on your network diagram. . Which tasks are on the critical path? Highligh Preceding Expected Critical Path? Activity Event Duration EF LF Slack A, D C,E D, E F, G...

  • (3) Determine the critical path and critical time of the network shown below. Use the critical...

    (3) Determine the critical path and critical time of the network shown below. Use the critical path method (the table of ES, EF, etc.). (3) Determine the critical path and critical time of the network shown below. Use the critical path method (the table of ES, EF, etc.). po Problem . Example a 100 For all starting activities, ES is taken as 0. Activities 1-2, 1-3 gets ES of O. Find EF-ES +time. Activity Time ES E F LS L...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max        Crash cost             Activity                           Predecessors           Time (weeks)             Crash*    per week                   A                                none                                    6                          6                N/A                   B                                none                                    5                          2               $500                   C                                A                                       3                          2             $1000                   D                                A, B                                    4                          2             $2000                   E                                 C, D                                    5                          2             $1250                   F                                D                                       6                          2             $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Consider the following project where times are in weeks. Activity Duration Immediate Predecessors A B с...

    Consider the following project where times are in weeks. Activity Duration Immediate Predecessors A B с D E F G H A.B B A с E,F 8 12 7 4 2 3 7 3 DF a) Determine the activity schedule (ES, EF, LS, and LF) as well as slack using the information from the table above (11 marks) b) Determine all the possible paths of this project and determine the shortest possible time this project can be completed? (4 marks)...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
