Question

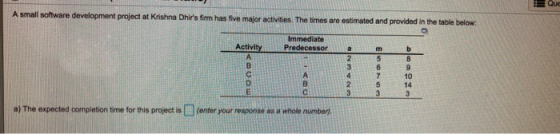

!!! Que A small software development project at Krishna Dhirs firm has five major activities. The times are estimated and pr
2. what is the project variance value of completion?
0 0
Add a comment Improve this question Transcribed image text
Answer #1

EXPECTED TIME = (A + (4M) + B) / 6; WHERE A = OPTIMISTIC TIME, M = MOST LIKELY TIME, B = PESSIMISTIC TIME

VARIANCE = ((B - A) / 6)**2


ACTIVITY

EXPECTED TIME

VARIANCE

A

(2 + (4 * 5) + 8) / 6 = 5

((8 - 2) / 6)^2 = 1

B

(3 + (4 * 6) + 9) / 6 = 6

((9 - 3) / 6)^2 = 1

C

(4 + (4 * 7) + 10) / 6 = 7

((10 - 4) / 6)^2 = 1

D

(2 + (4 * 5) + 14) / 6 = 6

((14 - 2) / 6)^2 = 4

E

(3 + (4 * 3) + 3) / 6 = 3

((3 - 3) / 6)^2 = 0


CPM


ACTIVITY

DURATION

ES

EF

LS

LF

SLACK(LF-EF)

CRITICAL

A

5

0

0 + 5 = 5

5 - 5 = 0

MIN LS(C) = 5

5 - 5 = 0

YES

B

6

0

0 + 6 = 6

9 - 6 = 3

MIN LS(D) = 9

9 - 6 = 3

C

7

MAX EF( A) = 5

5 + 7 = 12

12 - 7 = 5

MIN LS(E) = 12

12 - 12 = 0

YES

D

6

MAX EF( B) = 6

6 + 6 = 12

15 - 6 = 9

15

15 - 12 = 3

E

3

MAX EF( C) = 12

12 + 3 = 15

15 - 3 = 12

15

15 - 15 = 0

YES

FORWARD PASS: ES = MAXIMUM EF OF ALL PREDECESSOR ACTIVITIES; 0 IF NO PREDECESSORS ARE PRESENT. EF = ES + DURATION OF THE ACTIVITY

BACKWARD PASS: LF = MINIMUM LS OF ALL SUCCESSOR ACTIVITIES; COMPLETION TIME OF THE PROJECT IF NO SUCCESSORS ARE PRESENT. LS = LF - DURATION OF THE ACTIVITY

SLACK = LF - EF, OR, LS - ES

CRITICAL PATH = PATH WITH THE LONGEST COMBINED DURATION VALUE AND 0 SLACK

CRITICAL PATH = ACE

DURATION OF PROJECT = 15

VARIANCE OF PROJECT = VARIANCE OF CRITICAL PATH = 1 + 1 + 0 = 2

Do leave a like for the answer if you found it helpful.

Add a comment
Know the answer?
Add Answer to:
2. what is the project variance value of completion? !!! Que A small software development project...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • I need done in hour please A small software development project at Krishna Dhir's firm has...

    I need done in hour please A small software development project at Krishna Dhir's firm has five major activities. The times are estimated and provided in the table below Immediate Activity Predecessor a m b 4 7 10 a) The expected completion time for this project is (enter your response as a whole number b) The project varniance value of completion time is(enter your response as a whole number) Enter your answer in each of the answer boxes

  • A small software development project has eight major activities. The times are estimated and prov...

    A small software development project has eight major activities. The times are estimated and provided in the table below: Activity Optimistic Time Most Likely Time Pessimistic Time Immediate Predecessor(s) A 3 4 5 -- B 5 7 9 -- C 2 3 10 A D 2 5 8 B E 1 7 7 B F 3 5 7 C, D G 7 8 9 D, E H 2 6 10 F Answer the following questions based on above table 1-2...

  • QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are s...

    QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are shown follow. Time Immediate Activity (weeks) Predecessor 2 5 В 4 C 5 В 6 В.С D,E F What are the slack times of Activities D and E? 0 and 0, respectively 1 and 1, respectively 2 and 0, respectively 0 and 1, respectively 1 and 0, respectively shown follow. A firm is planning a project for the...

  • Development of Version 2.0 of a particular accounting software product is being considered by Jose Noguera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose Noguera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: Activity A Normal Time Crash Time Normal (weeks) (weeks) Cost 4 3 $2,000 2 $2,100 $750 Total Cost with Immediate Crashing Predecessor(s) $2,650 - $2,800 - $750 B 2 3 $2.400 $2,680 Ā $900 3 § $1,200 3 $900 $3,200 § $4,600 $9,500 $2,000...

  • Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: To Cost Normal Time (weeks) Crash Time Normal with Activity (weeks) Cost Crashing Immediate Predecessor(s) $2.700 A $2,000 7 $2,300 S3,100 3 $500 $500 S2,300 $2,580 A E 5900 $1.275 F F $3.400 2 S4,800 C G $1,500 $2.100 D, E a) Based on...

  • Development of a new deluxe version of a particular software product is being considered. The activities necessary for the completion of this are listed in the table below (Time in weeks). Activit...

    Development of a new deluxe version of a particular software product is being considered. The activities necessary for the completion of this are listed in the table below (Time in weeks). Activity Immediate Predecessor a m b A -- 2 5 8 B A 3 6 9 C A 4 7 10 D B 2 5 14 E D 3 3 3 F C 6 8 10 G E, F 1 1 1 H C 6 10 14 I G,...

  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations and what activities each must precede: Activity A (start) B с E F(end) Duration (weeks) 3 8 3 4 Precedes B, C F E F 2 This exercise contains only parts b, c, and d. b) The activities on the critical path are A-B-F c) The total project completion time for Rafay Ishfaq's software firm is 13 weeks. (Enter your...

  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations and what adivities each must precede Activity Duration (weeks) Precedes A (start) Fendi This exercise contains only parts and d. b) The activities on the critical path are c) The total project completion time for Rafay Ishlad's software firm is weeks. (Enter your response as a whole number) d) Determine the slack time for each of the activities. (Enter your...

  • 1) Based on the given information regarding the activities for the project, the project length= ___...

    1) Based on the given information regarding the activities for the project, the project length= ___ weeks. 2) The total cost required for completing this project on normal time= $____ 3) For reducing the duration of the project by one week, the activity that should be crashed first is activity ___. 4) The cost of the project based on the first activity selected for crashing will increase by $___. 5) The maximum weeks by which the project can be reduced...

  • Development of Version 20 of a particular accounting software product is being considered by Jose Noguera's...

    Development of Version 20 of a particular accounting software product is being considered by Jose Noguera's technology form in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: Immediate Predecessor(s) Activity Normal Time Crash Time Normal (weeks) (weeks) Cost $2,200 $2,200 5750 $2,300 $900 $3.000 $1,600 Total Cost with Crashing $2,850 $3.000 5750 $2.580 $1,200 $4.500 52.200 D.E d) The maximum weeks by which the project can be reduced by crashing =...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
