I need done in hour please

A small software development project at Krishna Dhirs firm has five major activities. The times are estimated and provided in the table below Immediate Activity Predecessor a m b 4 7 10 a) The expected completion time for this project is (enter your response as a whole number b) The project varniance value of completion time is(enter your response as a whole number) Enter your answer in each of the answer boxes
0 0
Add a comment Improve this question Transcribed image text
Answer #1

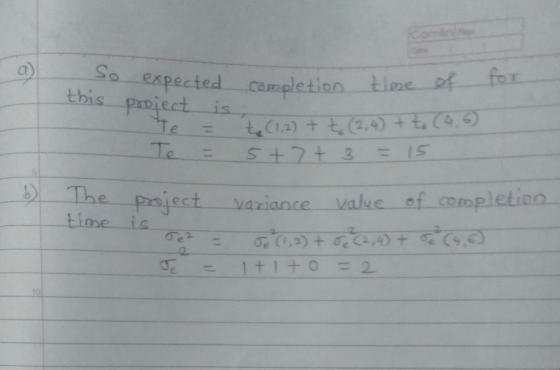

a)  The expected complition time for these project is 15

b) The project variance value of complition time is 2

=> detailed solution is given following -

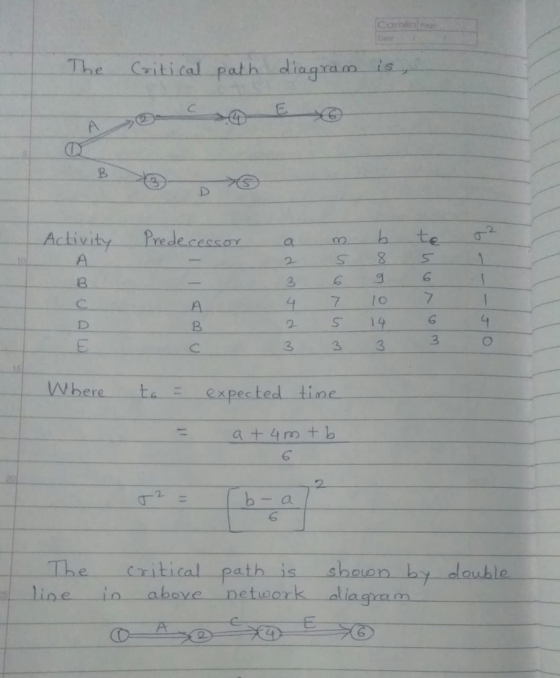

Cornling The Criti cal t-Activity __Prede cessor a 3 66 4 7o7 2146 3 3 33o Where texpected tine b-a 6 be ine in above network aliaganm path is shaon by dloubl

Add a comment
Know the answer?
Add Answer to:
I need done in hour please A small software development project at Krishna Dhir's firm has...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • 2. what is the project variance value of completion? !!! Que A small software development project...

    2. what is the project variance value of completion? !!! Que A small software development project at Krishna Dhir's firm has five major activities. The times are estimated and provided in the table below: Activity Immediate Predecessor a 2 الما COO m 5 6 7 5 3 b 8 9 10 14 3 4 2 3 a) The expected completion time for this project is (enter your response as a whole number),

  • A small software development project has eight major activities. The times are estimated and prov...

    A small software development project has eight major activities. The times are estimated and provided in the table below: Activity Optimistic Time Most Likely Time Pessimistic Time Immediate Predecessor(s) A 3 4 5 -- B 5 7 9 -- C 2 3 10 A D 2 5 8 B E 1 7 7 B F 3 5 7 C, D G 7 8 9 D, E H 2 6 10 F Answer the following questions based on above table 1-2...

  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations and what adivities each must precede Activity Duration (weeks) Precedes A (start) Fendi This exercise contains only parts and d. b) The activities on the critical path are c) The total project completion time for Rafay Ishlad's software firm is weeks. (Enter your response as a whole number) d) Determine the slack time for each of the activities. (Enter your...

  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations and what activities each must precede: Activity A (start) B с E F(end) Duration (weeks) 3 8 3 4 Precedes B, C F E F 2 This exercise contains only parts b, c, and d. b) The activities on the critical path are A-B-F c) The total project completion time for Rafay Ishfaq's software firm is 13 weeks. (Enter your...

  • The following is a table of activities associated with a project at Rafay​ Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay​ Ishfaq's software firm in​ Chicago, their durations and what activities each must​ precede: Activity Duration​ (weeks) Precedes A​ (start) 2 ​B, C B 2 E C 6 F E 3 F F​ (end) 4 — This exercise contains only parts​ b, c, and d. ​b) Define the critical​ path, listing all critical activities in chronological order. Critical path activities are the activities that lie on the longest...

  • QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are s...

    QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are shown follow. Time Immediate Activity (weeks) Predecessor 2 5 В 4 C 5 В 6 В.С D,E F What are the slack times of Activities D and E? 0 and 0, respectively 1 and 1, respectively 2 and 0, respectively 0 and 1, respectively 1 and 0, respectively shown follow. A firm is planning a project for the...

  • er Ginde is developing a program in supply chain management certification for managers. Ginde has listed...

    er Ginde is developing a program in supply chain management certification for managers. Ginde has listed a number of activities that must be completed before a training program of this nature could be ucted. The activities, immediate predecessors, and times appear in the accompanying table: Activity immediate Predecessor(s) Time (days) s exercise contains only parts b, c, and d. The critical activities for the leadership training program development project are The project length for the leadership training program development project...

  • Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: To Cost Normal Time (weeks) Crash Time Normal with Activity (weeks) Cost Crashing Immediate Predecessor(s) $2.700 A $2,000 7 $2,300 S3,100 3 $500 $500 S2,300 $2,580 A E 5900 $1.275 F F $3.400 2 S4,800 C G $1,500 $2.100 D, E a) Based on...

  • Development of Version 2.0 of a particular accounting software product is being considered by Jose Noguera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose Noguera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: Activity A Normal Time Crash Time Normal (weeks) (weeks) Cost 4 3 $2,000 2 $2,100 $750 Total Cost with Immediate Crashing Predecessor(s) $2,650 - $2,800 - $750 B 2 3 $2.400 $2,680 Ā $900 3 § $1,200 3 $900 $3,200 § $4,600 $9,500 $2,000...

  • Development of Version 20 of a particular accounting software product is being considered by Jose Noguera's...

    Development of Version 20 of a particular accounting software product is being considered by Jose Noguera's technology form in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: Immediate Predecessor(s) Activity Normal Time Crash Time Normal (weeks) (weeks) Cost $2,200 $2,200 5750 $2,300 $900 $3.000 $1,600 Total Cost with Crashing $2,850 $3.000 5750 $2.580 $1,200 $4.500 52.200 D.E d) The maximum weeks by which the project can be reduced by crashing =...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
