NOTE: PLEASE LIKE THE ANSWER, IT WILL ENCOURAGE ME. IF YOU HAVE
ANY DOUBTS AND QUERIES ON THIS ANSWER PLEASE FEEL FREE TO COMMENT
BELOW. I WILL REPLY "ASAP" AND PLEASE DONT DISLIKE THIS
ANSWER.
HOPE I ANSWERED YOUR QUESTION.
THANK YOU.........

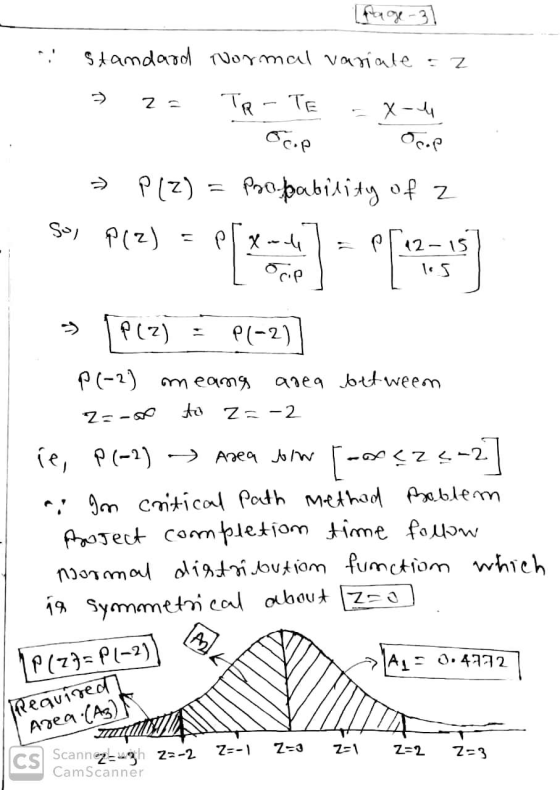

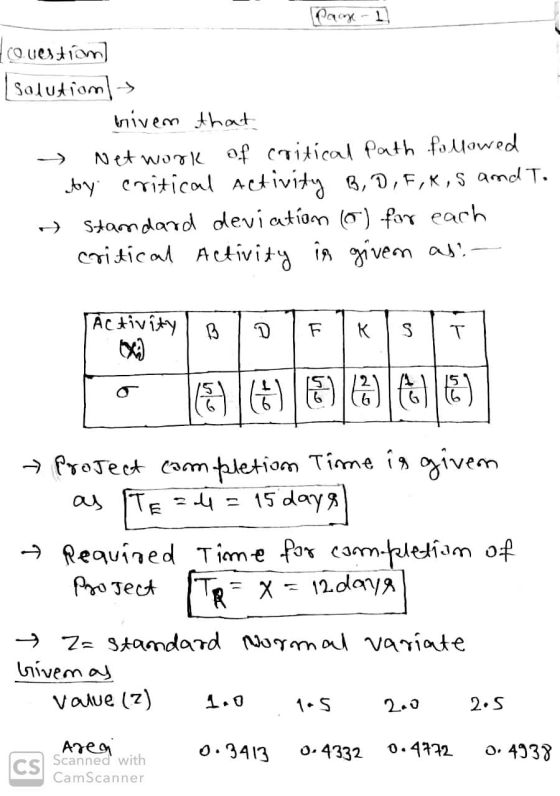

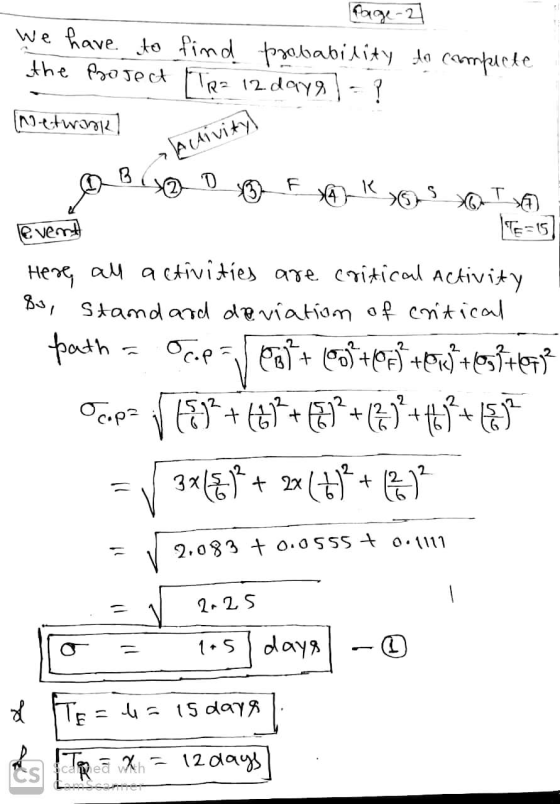

![Pange-1 tovestiam] [solution hivem that Network of critical Path followed by critical activity B, D, F,K,S and T. Standard de](http://img.homeworklib.com/questions/af849080-9042-11eb-9455-4342f09976f6.png?x-oss-process=image/resize,w_560)

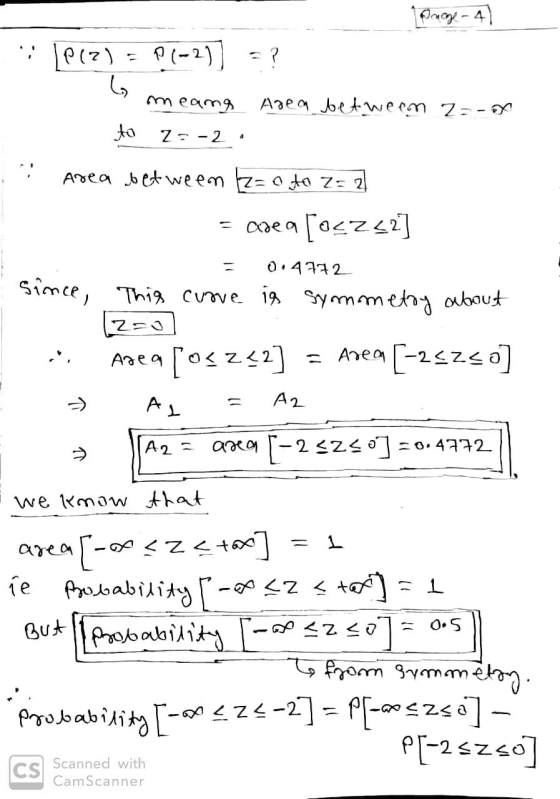

![-4. ; 12(7) = P(-2)] = ? 6 meang Area between 2-ox to 2: -2 4 Area between 2=0 to 7= 2 adea [ocz_2] 0.4772 since, This curre](http://img.homeworklib.com/questions/b19cd6f0-9042-11eb-b499-e3c4ed1e416d.png?x-oss-process=image/resize,w_560)

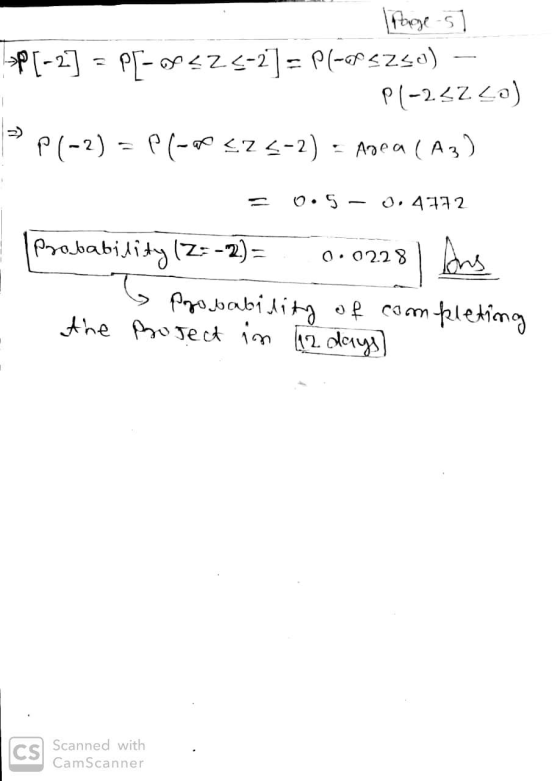

![Page 5 P[-2] = PT-224-2] = P(-3250) P(-232 Lo) P(-2) P(-ac24-2) = Area (A3) > 0.5 0.4772 Probability (2=-* -2) = 0.02.28 Ans](http://img.homeworklib.com/questions/b24001b0-9042-11eb-81e7-7db3d7bfcbfc.png?x-oss-process=image/resize,w_560)

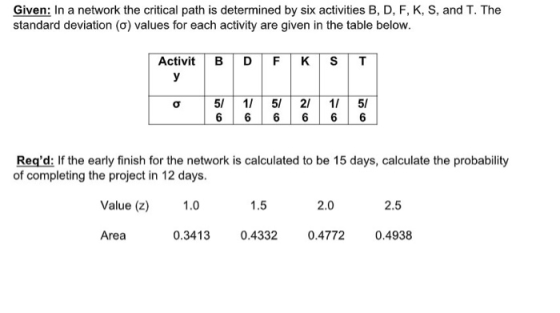

Given: In a network the critical path is determined by six activities B, D, F, K,...
