Question

An electric utility is planning its annual project of shutting down one of its steam boilers...

An electric utility is planning its annual project of shutting down one of its steam boilers for maintenance and repair, an analysis of this project has identified the following principal activities and their expected times and relationships.

Activity Time: (Days): Immediate: Predecessor

A: 4: --

B: 3: --

C: 4: --

D: 6: A

E: 3: A

F: 5: C

G: 4: D

H: 6: A,B,F

I: 2 :E,G,H

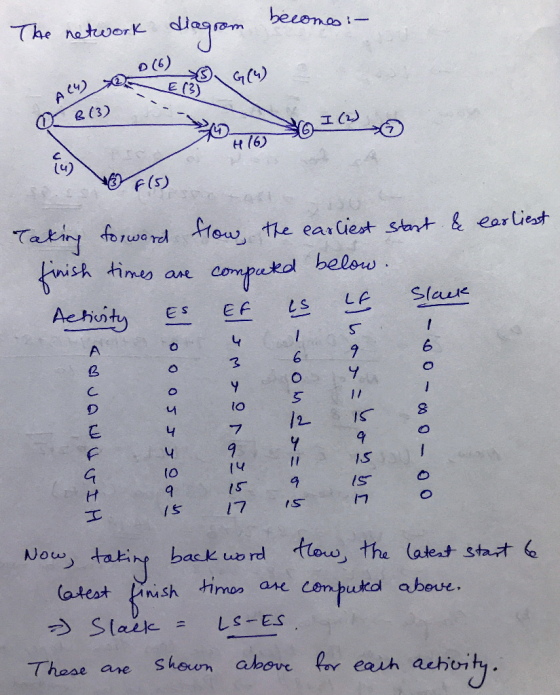

Calculate the scheduling times for each activity

0 0
Add a comment Improve this question Transcribed image text
Know the answer?
Add Answer to:
An electric utility is planning its annual project of shutting down one of its steam boilers...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are s...

    QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are shown follow. Time Immediate Activity (weeks) Predecessor 2 5 В 4 C 5 В 6 В.С D,E F What are the slack times of Activities D and E? 0 and 0, respectively 1 and 1, respectively 2 and 0, respectively 0 and 1, respectively 1 and 0, respectively shown follow. A firm is planning a project for the...

  • The following activities of a hospital expansion project has been identified in the following table. First,...

    The following activities of a hospital expansion project has been identified in the following table. First, all activities of the project are listed. Next, the immediate predecessor(s) of each activity is identified (activity relationships). Please plot the activity network diagram and answer the following questions. Hospital Expansion Project Activity Description Immediate predecessor(s) Activity Time (Weeks) A Select administrative and medical staff - 12 B Select site and do site survey - 9 C Select equipment A 10 D Prepare final...

  •                            Barbara​ Gordon, the project manager for Web​ Ventures, compiled a table showing time estimate for each...

                               Barbara​ Gordon, the project manager for Web​ Ventures, compiled a table showing time estimate for each of the​company's manufacturing activities of a project. The list of​ activities, immediate​ predecessors, and estimated times appear in the following​ table:                                                                                  Activity Immediate​ Predecessor(s) Time​ (days) A - 4 B - 6 C - 1 D B 10 E ​A, D F C 5 G ​E, F 12 ​a) Therefore, the critical activities for the manufacturing project are (A - E - G,...

  • project management

    1.     Ross Hopkins, president of Hopkins Hospitality, has developed the tasks, durations, and predecessor relationships in the following table for building new motels.  ActivityTime (weeks)a         m           bImmediatePredecessor(s) Activity aTime (weeks)m bImmediatePredecessor(s)A4810—G234C, EB2824AH222FC81216AI666FD4610AJ4612D, G, HE123BK223I, JF6820C, E a)  The expected (estimated) time for activity C is                         weeks. (Round your response to two decimal places.) b)  The variance for activity C is                         weeks. (Round your response to two decimal places.) c)  Based on the calculation of the estimated times, the critical path...

  • Case-2 Consider that you have an interview in a construction firm and they asked you to...

    Case-2 Consider that you have an interview in a construction firm and they asked you to develop an (AOA) network for a construction project has the following activities along with their relationships. Draw your suggested network. (15 Marks) (The project was started in activity A and it is the precedence of activities B,C,D &E, the activity B is followed by activity F, while the activity C was followed by activity G, the activity K was not start until the activities...

  • The director of continuing education at Bluebird University just approved the planning for a sales training...

    The director of continuing education at Bluebird University just approved the planning for a sales training seminar. Her administrative assistant identified the various activities that must be done and their relationships to each other as shown below. Time Estimates Activity Description Immediate Predecessor(s) Optimistic Most likely Pessimistic A Prepare course outline None 3 4 5 B Identify potential teachers None 4 6 8 C Send potential students course outline A 8 10 12 D Select teacher B 2 3 4...

  • A project for improving a billing process has the following precedence relationships and activity times: Activity...

    A project for improving a billing process has the following precedence relationships and activity times: Activity Activity Time (weeks) Immediate Predecessor(s) B, C I Q7 Moow E F, G b. Calculate the slack for each activity. Which activities are on the critical path? Activity Activity Time (weeks) On critical path? Yes Slack (weeks) D 0 Yes 0 0 00000000 @ Tm I

  • A project manager has compiled a list of major activities that will be required to install...

    A project manager has compiled a list of major activities that will be required to install a computer information system in her firm. The list includes estimated completion times for activities and precedence relationships. (Z-Table is needed) Activity Immediate Predecessor Estimated Times (weeks) A — 2-4-6 D A 6-8-10 E D 7-9-12 H E 2-3-5 F A 3-4-8 G F 5-7-9 B — 2-2-3 I B 2-3-6 J I 3-4-5 K J 4-5-8 C — 5-8-12 M C 1-1-1 N...

  • Consider the following network for a small maintenance project (all times are in days). [7 Marks]...

    Consider the following network for a small maintenance project (all times are in days). [7 Marks] Activity Immediate Predecessor [s] Optimistic Time Most Likely Time Pessimistic Time A - 2 3 4              B - 5 6 7 C - 5 6 7 D A 3 4 5 E A 2 3 4 F C 3 4 5 G C 8 10 16 H B, E, F 5 6 7 I B, E, F 7 11 15 J B, E,...

  • project are listed for a In the following table the activities with their precedence sequence and...

    project are listed for a In the following table the activities with their precedence sequence and expected time (days) Immediate Predecessor(s) Time (days) Activity 7 A 2 A B 4 C 4 5 5 E C F 2 G E, F 3 H G, H a) The activities on the critical path are b) The project length is days.

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
