Question

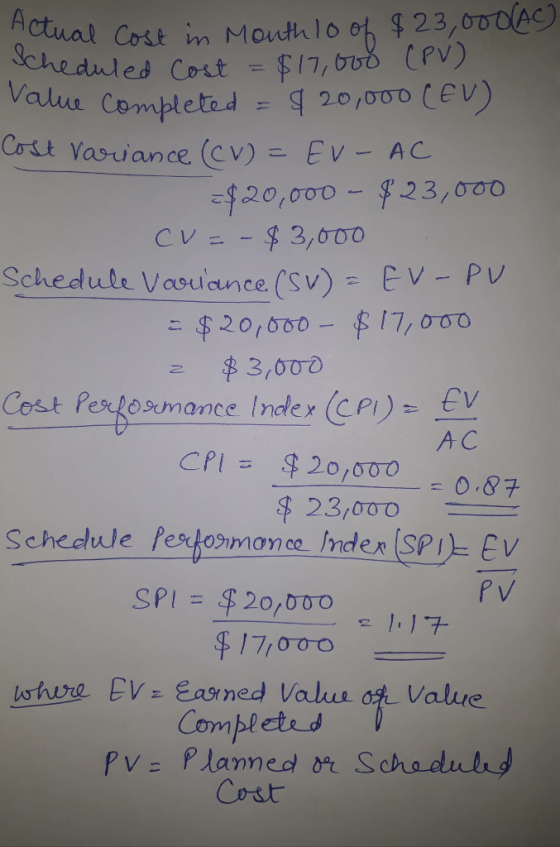

5. A consulting project has an actual cost in month 10 of $23.000, a scheduled cost of $17,000, and a value com pleted of $20,000. Find the schedule and cost variances and the three indexes.
0 0
Add a comment Improve this question Transcribed image text
Know the answer?
Add Answer to:
5. A consulting project has an actual cost in month 10 of $23.000, a scheduled cost...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • 4. A project to develop a county park has an actual cost in month 17 of...

    4. A project to develop a county park has an actual cost in month 17 of $350,000, a planned cost of $475,000, and a value completed of S300,000. Find the cost and schedule variances and the three indexes.

  • #1. A project in its 26th week has an actual cost of $270,000. It was scheduled...

    #1. A project in its 26th week has an actual cost of $270,000. It was scheduled to have spent $261,000. For the work performed to date, the budgeted value is $272,000. What are the cost and schedule variances for the project? What are the SPI and CPI? What is your assessment of the project from a cost and schedule perspective? #2. A project has just completed the 87th item in its plan. It was scheduled to have spent $168,000 at...

  • 2. Find the schedule and cost variances for a project that has as actual cost at...

    2. Find the schedule and cost variances for a project that has as actual cost at month 16 of $540,000, a scheduled cost of $523,000, and an earned value of $535,000. What do the results tell you?

  • Determine the schedule and cost variance for a project that has an actual cost at month...

    Determine the schedule and cost variance for a project that has an actual cost at month 10 of $600,000, a scheduled cost of $600,000 and an earned value of $600,000.

  • 2. A sales project at month 5 had an actual cost of $34,000, a planned cost...

    2. A sales project at month 5 had an actual cost of $34,000, a planned cost of $42,000, and a value completed of $39,000. Find the cost and schedule variances and the CPI and SPI

  • 3. A software development project at day 70 exhibits an actual cost of $78,000 and a...

    3. A software development project at day 70 exhibits an actual cost of $78,000 and a scheduled cost of $84,000 The software manager estimates a value completed of $81,000. What are the cost and schedule variances and CSI? Estimate the time variance.

  • For a project, in X day, planned value, earned value and actual cost of the tasks...

    For a project, in X day, planned value, earned value and actual cost of the tasks are given in dollar in the table below. Planned $1000 to complete project. Task Actual Cost Work Performed Budgeted Cost Work Scheduled 50 70 30 100 50 2 3 4 5 Budgeted Cost Work Performed 50 70 30 50 0 Total: 250 a. Find schedule and cost variance. Explain what it means? b. Find schedule and cost performance index. c. Find estimate to complete...

  • A project has an Earned Value (EV) = $5, Actual Cost (AC) = $7 and both...

    A project has an Earned Value (EV) = $5, Actual Cost (AC) = $7 and both Cost Performance Index (CPI) and Schedule Performance Index (SPI) equal 0.90. The original project budget is $10. Assuming the remaining work will be impacted by the current cost performance and current schedule performance, what is the estimate at completion (EAC) of the project? $12.96 $13.17 $14.75 $15 What is your reasoning? ________________________________________________________

  • Activity PV (in $) EV (in $) AC A 9,200 10,000 9,700 B 23,000 20,000 18,000...

    Activity PV (in $) EV (in $) AC A 9,200 10,000 9,700 B 23,000 20,000 18,000 C 12,000 13,000 11,000 D 8,000 10,000 12,000 E 10,000 12,000 13,000 F 7,000 9,000 10,000 G 8,000 9,000 10,000 Find the schedule and cost variances for a project that has an actual cost at month 22 of $540,000, a scheduled cost of $523,000, and an earned value of $535,000.

  • You are given the following information for a one-year project: Planned Value (PV) = $23,000, Earned...

    You are given the following information for a one-year project: Planned Value (PV) = $23,000, Earned Value (EV) = $20,000, Actual Cost (AC) = $20,000, and Budget at Completion (BAC) = $120,000. Explain your assessment on how the project is doing: Is it ahead or behind schedule? Is it Page 6 of 8 IS8100-01 Fa2019 under or over budget? Use all of the calculated variances and indexes from above to support your argument. [50-100-word response.]

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
