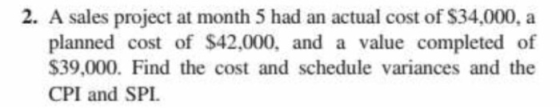

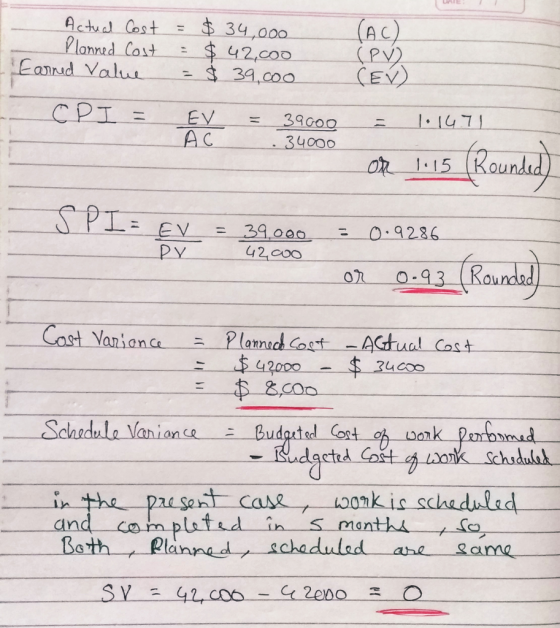

2. A sales project at month 5 had an actual cost of $34,000, a planned cost...
#1. A project in its 26th week has an actual cost of $270,000. It was scheduled to have spent $261,000. For the work performed to date, the budgeted value is $272,000. What are the cost and schedule variances for the project? What are the SPI and CPI? What is your assessment of the project from a cost and schedule perspective? #2. A project has just completed the 87th item in its plan. It was scheduled to have spent $168,000 at...
4. A project to develop a county park has an actual cost in month 17 of $350,000, a planned cost of $475,000, and a value completed of S300,000. Find the cost and schedule variances and the three indexes.
7. Given an activity in an advertising project whose planned cost was $12,000 but actual cost to date is $10,000 so far and the value completed is only 70 percent, calculate the cost and schedule variances. Will the client be pleased or angry?
2. You are 4.5 months into a 6-month, $12,000 project with a planned linear spend rate. You have an earned value of $8,500 and you have spent $10,000. What is your EAC? (2 points) 3. The earned value on your project is $15,000, the planned value is $20,000, and the actual cost is $18,000. What is your current schedule variance (in $)? (1 point) 5. You are working on a large project and have determined that your cost variance is...
Activity PV (in $) EV (in $) AC A 9,200 10,000 9,700 B 23,000 20,000 18,000 C 12,000 13,000 11,000 D 8,000 10,000 12,000 E 10,000 12,000 13,000 F 7,000 9,000 10,000 G 8,000 9,000 10,000 A project to develop a country park has an actual cost in month 17 of $350,000, a planned cost of $475,000, and a value completed of $300,000. Find the cost and schedule variances, and CPI and SPI. What meaning do you derive from the...
5. A consulting project has an actual cost in month 10 of $23.000, a scheduled cost of $17,000, and a value com pleted of $20,000. Find the schedule and cost variances and the three indexes.
You are given the following information for a one-year project: Planned Value (PV) - $23,000, Earned Value (EV) - $20,000, Actual Cost (AC) = $20,000, and Budget at Completion (BAC) = $120,000. Answer each of the questions below to complete your assignment. Use the same numbers as the assignment when you give your answer, I only grade answers that correspond the assignment questions. 1. For this one-year project calculate: a. cost variance, b. schedule variance, C. cost performance index (CPI),...
A project has an Earned Value (EV) = $5, Actual Cost (AC) = $7 and both Cost Performance Index (CPI) and Schedule Performance Index (SPI) equal 0.90. The original project budget is $10. Assuming the remaining work will be impacted by the current cost performance and current schedule performance, what is the estimate at completion (EAC) of the project? $12.96 $13.17 $14.75 $15 What is your reasoning? ________________________________________________________
For a project, in X day, planned value, earned value and actual cost of the tasks are given in dollar in the table below. Planned $1000 to complete project. Task Actual Cost Work Performed Budgeted Cost Work Scheduled 50 70 30 100 50 2 3 4 5 Budgeted Cost Work Performed 50 70 30 50 0 Total: 250 a. Find schedule and cost variance. Explain what it means? b. Find schedule and cost performance index. c. Find estimate to complete...
14. The following project is at the end of its sixth week. Find the cost and schedule variances. Also find the CPI. SPI ETC, and EAC for the project. Duration Budget, Actual Cost, $ 400 180 decessors (weeks) Complete 100 100 100 20 20 250 600 400 200
