Answer:
| Actual cost or AC = $350,000, |
| Planned cost or PV = $475,000, |
| Value completed or earned value (EV) = $300,000 |
| Cost Variance (CV) = 300,000 – 350,000 |
| = -50,000 |
| Schedule Variance(SV) = 300,000 – 475,000 |
| = -175,000 |
| Cost Performance Index (CPI) = Earned value/Actual cost |
| = 300,000/350,000 |
| = 0.8571 |
| Schedule Performance Index (SPI) = Earned value/Planned Cost |
| = 300,000/475,000 |
| = 0.6316 |
| Scheduled Time Work Performed (STWP) | ||
| Time ( t) = Schedule Variance/Slope of Planned costs = -175,000/ (475,000/17) | ||
| = - 6.2631months | ||
| Time Difference = 17- 6.2631 = 10.7369 | ||
| Time Variance = 10.7369/17 = 0.6316 |

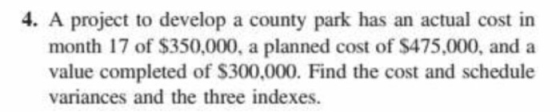

4. A project to develop a county park has an actual cost in month 17 of...
5. A consulting project has an actual cost in month 10 of $23.000, a scheduled cost of $17,000, and a value com pleted of $20,000. Find the schedule and cost variances and the three indexes.
Activity PV (in $) EV (in $) AC A 9,200 10,000 9,700 B 23,000 20,000 18,000 C 12,000 13,000 11,000 D 8,000 10,000 12,000 E 10,000 12,000 13,000 F 7,000 9,000 10,000 G 8,000 9,000 10,000 A project to develop a country park has an actual cost in month 17 of $350,000, a planned cost of $475,000, and a value completed of $300,000. Find the cost and schedule variances, and CPI and SPI. What meaning do you derive from the...
2. A sales project at month 5 had an actual cost of $34,000, a planned cost of $42,000, and a value completed of $39,000. Find the cost and schedule variances and the CPI and SPI
2. Find the schedule and cost variances for a project that has as actual cost at month 16 of $540,000, a scheduled cost of $523,000, and an earned value of $535,000. What do the results tell you?
#1. A project in its 26th week has an actual cost of $270,000. It was scheduled to have spent $261,000. For the work performed to date, the budgeted value is $272,000. What are the cost and schedule variances for the project? What are the SPI and CPI? What is your assessment of the project from a cost and schedule perspective? #2. A project has just completed the 87th item in its plan. It was scheduled to have spent $168,000 at...
7. Given an activity in an advertising project whose planned cost was $12,000 but actual cost to date is $10,000 so far and the value completed is only 70 percent, calculate the cost and schedule variances. Will the client be pleased or angry?
Determine the schedule and cost variance for a project that has an actual cost at month 10 of $600,000, a scheduled cost of $600,000 and an earned value of $600,000.
6. A project to develop technology training seminars is 5 days behind schedule at day 65. It had a planned cost of $735,000 for this point in time, but the actual cost is only $550,000. Estimate the schedule and cost variances. Re-estimate the variances if the actual cost had been $750,000
For a project, in X day, planned value, earned value and actual cost of the tasks are given in dollar in the table below. Planned $1000 to complete project. Task Actual Cost Work Performed Budgeted Cost Work Scheduled 50 70 30 100 50 2 3 4 5 Budgeted Cost Work Performed 50 70 30 50 0 Total: 250 a. Find schedule and cost variance. Explain what it means? b. Find schedule and cost performance index. c. Find estimate to complete...
3. A software development project at day 70 exhibits an actual cost of $78,000 and a scheduled cost of $84,000 The software manager estimates a value completed of $81,000. What are the cost and schedule variances and CSI? Estimate the time variance.
