Question

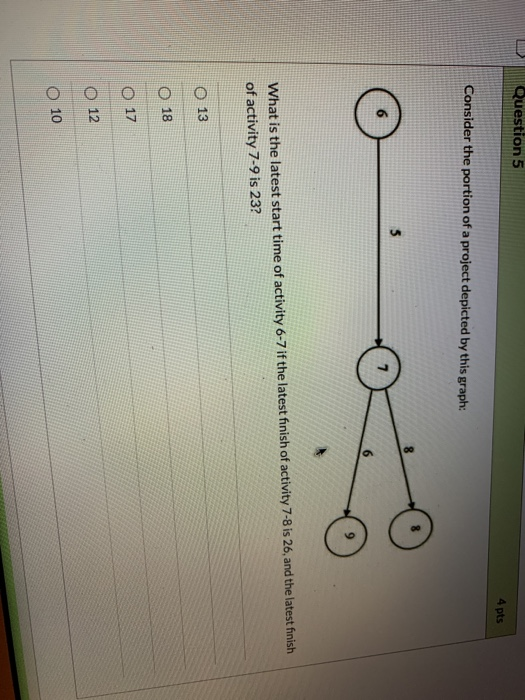

Question 5 4 pts Consider the portion of a project depicted by this graph: 5 What is the latest start time of activity 6-7 if
0 0
Add a comment Improve this question Transcribed image text
Answer #1

The correct answer is option 4

-----------------------------------------------------------------------------------------

Latest start time of activity 6 - 7 = Latest finish of activity (6-7) - activity time of ( 6 - 7)

Latest finish of activity 6- 7 = Minimum of latest start of activity (7-8) , ( 7 - 9)

Latest start of activity (7-8) = 26 - 8 = 18

Latest start of activity ( 7 - 9) = 23 - 6 = 17

Latest finish of activity 6- 7 = Minimum of latest start of activity (7-8) , ( 7 - 9) = 17

Latest start of activity (6 - 7) = 17 - 5 = 12

Add a comment
Know the answer?
Add Answer to:
Question 5 4 pts Consider the portion of a project depicted by this graph: 5 What...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • 39. Consider the following project, and answer the next 5 questions based on this data: Task...

    39. Consider the following project, and answer the next 5 questions based on this data: Task ID Duration (Days) Predecessors 2 70 - 3 30 2 4 120 3 5 120 2 6 120 5 7 120 3,6 8 150 3,6 9 115 3,6 10 130 7,9 11 90 7,9 12 30 7,9 13 120 7,9 14 75 10 15 30 14 16 85 6 17 165 16 18 90 16 19 90 17,18 20 20 8,11,13,15,19 What is the...

  • Consider the following project. Activity ImmediateActivity Time (days) Predecessor CD E,F What is the critical path? O ACFG O ADFG OBEG ACDFG What is the latest finish time for activity F? 0 9 O...

    Consider the following project. Activity ImmediateActivity Time (days) Predecessor CD E,F What is the critical path? O ACFG O ADFG OBEG ACDFG What is the latest finish time for activity F? 0 9 O 13 O 16 What is the latest possible time that Activity E can be started without delaying the completion of the project? What is the latest time that activity B can finish without delaying any other activities? 4 What is the latest time that activity B...

  • Question 13 The following table provides a list of activities in a project, along with their...

    Question 13 The following table provides a list of activities in a project, along with their respective durations and precedence requirements: Immediate Duration Activity Predecessor(s) (weeks) A 2 B 3 с 2 D A,B 5 E CD F D 4 G E 2 1 Determine the duration of the project. a. 13 weeks b. 12 weeks OC. 11 weeks d. 10 weeks e. 9 weeks Question 14 Assume that activity F has the following times: Early start time (ES) =...

  • QUESTION 1 G E. H. C A Finish Start D. Complete the network activity diagram using the table below to answer questio...

    QUESTION 1 G E. H. C A Finish Start D. Complete the network activity diagram using the table below to answer questions 1-15. The expected activity completion times are provided in days. Each question is 1 point. Most Probable Activity Optimistic Pessimistic A 7 B 12 C 5 12 7 E 10 15 20 6 9 18 G 6 13 H 11 What is the early start (ES) time for activity F? 13 12 10 None of the above are...

  • 1. Consider the following table providing the needed tasks to completing a successful project. Th...

    1. Consider the following table providing the needed tasks to completing a successful project. The first column provides the name of the task, the second column states the time to complete that task and the third column tells when a task can begin. Task Time to Condition to start task complete #1 #2 #3 #4 #5 #6 #7 #8 #9 #10 #11 #12 #13 #14 #15 #16 #17 #18 #19 7 days None 5 days 8 daysNone 4 days 3...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max            Crash cost             Activity                           Predecessors          Time (weeks)             Crash*    per week                   A                                none                                    7                          7         N/A                   B                                none                                    3                          2        $500                   C                                A                                       5                          3      $1000                   D                                A, B                                    6                          4      $2000                   E                                 C, D                                    4                          3      $1250                   F                                D                                       3                          2      $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Consider a project network that begins with activity A and is followed by activity B. Activity...

    Consider a project network that begins with activity A and is followed by activity B. Activity A takes 6 days to finish. If the earliest start time for activity B is 6 days and the latest start time for it is 10 days, activity B has a slack of _____. 4 days 16 days 10 days 12 days

  • QUESTION 5 Given is a CPM project network diagram as shown below. А F Start E...

    QUESTION 5 Given is a CPM project network diagram as shown below. А F Start E H End B D G Start A B C D E F G H End Activity day 0 6 زر 8 7 4 9 4 6 0 a) The Project Completion time = days. b) The Earliest Start time, ES, of Activity G= days. c) The Latest Finish time, LF, of Acitivity C = days. d) The critical activities are = (ex. Fill in...

  • please show answers clearly 12 points Save Answer QUESTION 5 Given is a CPM project network...

    please show answers clearly 12 points Save Answer QUESTION 5 Given is a CPM project network diagram as shown below. F А H End E Start G B D E F Activity day Start 0 A 5 B 6 Ula G 5 H 4 End 0 ON 9 8 days. a) The Project Completion time = days. b) The Earliest Start time, ES, of Activity G= days.. c) The Latest Finish time, LF, of Acitivity C = d) The critical...

  • 1. The activities needed for a new project your company is undertaking are listed in the...

    1. The activities needed for a new project your company is undertaking are listed in the following table. ACTIVITY IMMEDIATE PREDECESSOR(S) A ---- B ---- C A D A, B E B F C, D, E G D, E H F I F, G J G The activity times were determined for the project, and were as below. ACTIVITY ACTIVITY TIME (days) A 11 B 9 C 7 D 12 E 8 F 9 G 10 H 6 I 7...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
