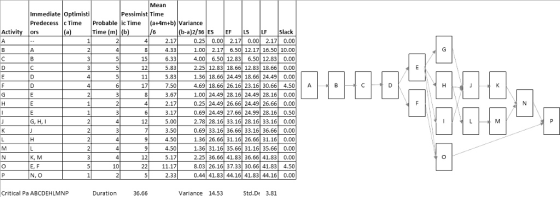

Florida Power & Light is attempting to modernize the meters placed at people houses. The company Operations Manager, Mr. Jacob Marina, has asked for your assistance in preparing part of the project plan. Mr. Marina has identified the tasks, durations (in days), and predecessor relationships, and provides them in the following table:
Immediate Most
Activity Predecessor(s) Optimistic Likely Pessimistic
A -- 1 2 4
B A 2 4 8
C B 3 5 15
D C 3 5 12
E D 4 5 11
F D 4 6 17
G E 2 3 8
H E 1 2 4
I E 1 3 6
J G, H, I 2 4 12
K J 2 3 7
L H 2 4 9
M L 2 4 9
N K, M 3 4 12
O E, F 5 10 22
P N, O 1 2 5
Required:
Answer-
All activities on Critical Path (ABCDEHLMNP) are candidates for crashing since they are on critical path and reduction in activity times for these activities will reduce the project duration.

Florida Power & Light is attempting to modernize the meters placed at people houses. The company...
Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A в B C D E, F D G The following table contains the pessimistic, likely, and optimistic estimates for how long activities are estimated to take for Project A. Activity Pessimistic Likely Optimistic 2 5 20 H 16 e. Calculate the time estimates (TE) f. Calculate the variance (s) g. Convert the TE to whole integers and place them in the network diagram for...
tual code de a Activity Predecessor Normal time A 2 B 3 C B A С 5 G. F H 15 HH 2 D И N M, J 1 - Calculate early start (ES), early finish (EF), late start (LS) and late finish (LF) for each activity - Draw Activity on Arrow network (AOA) - Draw Activity on Node network (AON) - Calculate slack of each activity - Determine the critical paths. There must be at least 2 critical paths...
The ABC Manufacturing Co. has made a decision to replace an existing production line with new equipment. This project will require several tasks (jobs) with precedence relationships and duration (days) as shown in the following table. The project will be finished when activities A-J are all finished. Activity predecessor Optimistic Most likely Pessimistic Expected A - 4 5 12 B A 3 4.5 15 C A 2 3 4 D C 6 8 22 E B 4 6 8 F...
Consider the following project activities:
Calculate the expected time (te) for each
activity.
Draw an Activity on Node (AON) diagram to reflect the flow of
these activities.
Calculate the Early Start (ES), Early Finish (EF), Late Start
(LS), and Late Finish (LF) for each activity.
Calculate the slack for each activity.
Identify all activities on the Critical Path.
Use the data to calculate the probability the project will
finish in 20 weeks (Hint: z-score).
Activity A 8 с D E...
A small software development project has eight major activities. The times are estimated and provided in the table below: Activity Optimistic Time Most Likely Time Pessimistic Time Immediate Predecessor(s) A 3 4 5 -- B 5 7 9 -- C 2 3 10 A D 2 5 8 B E 1 7 7 B F 3 5 7 C, D G 7 8 9 D, E H 2 6 10 F Answer the following questions based on above table 1-2...
Please show me the answer and how to place it on a spreadsheet. Thanks. 13.7 Table EX 13.7 shows the precedence relationships among the activities to complete a project. Table EX 13.7 Activity Predecessor Duration (Weeks) A – 6 B – 2 C A 4 D B 5 E B 2 F C, D 4 G C, D 7 H E, G 5 I F 4 Construct an activity on node network for the project. Identify the paths and path...
1. The activities needed for a new project your company is undertaking are listed in the following table. ACTIVITY IMMEDIATE PREDECESSOR(S) A ---- B ---- C A D A, B E B F C, D, E G D, E H F I F, G J G The activity times were determined for the project, and were as below. ACTIVITY ACTIVITY TIME (days) A 11 B 9 C 7 D 12 E 8 F 9 G 10 H 6 I 7...
Pik-Fast, a chain of convenience stores, is planning to open a new store. The activities required, their immediate predecessors, and the optimistic, most likely, and pessimistic estimates of their times (in days) are provided below. Activity Description Immediate Predecessors Optimistic Time (days) Most Likely Time (days) Pessimistic Time (days) TE ES EF LF LS Slack Standard Dev Variance A Select manager -- 10 12 20 13 0 1.67 B Select site -- 8 15 22 15 0 2.33 C Hire workers...
(15 points) Activity Immediate Predecessor Optimistic Time Most likely Time Pessimistic Time A NONE 4 7 9 B A 2 4 6 C A 6 9 9 D B, C 5 5 5 E C 2 5 9 F D, E 3 3 6 Use both the longest path method and ES/EF; LS/LF method for the following questions (e) What are the slack values for non-critical activities? (4 points) (f) What is the probability that the project will be...
Pik-Fast, a chain of convenience stores, is planning to open a new store. The activities required, their immediate predecessors, and the optimistic, most likely, and pessimistic estimates of their times (in days) are provided below. Activity Description Immediate Predecessors Optimistic Time (days) Most Likely Time (days) Pessimistic Time (days) TE ES EF LF LS Slack Standard Dev Variance A Select manager -- 10 12 20 13 0 1.67 B Select site -- 8 15 22 15 0 2.33 C Hire workers...
